Regional Goods Movement Questionnaire
Project Information
Agency Name | TxDOT Houston District |

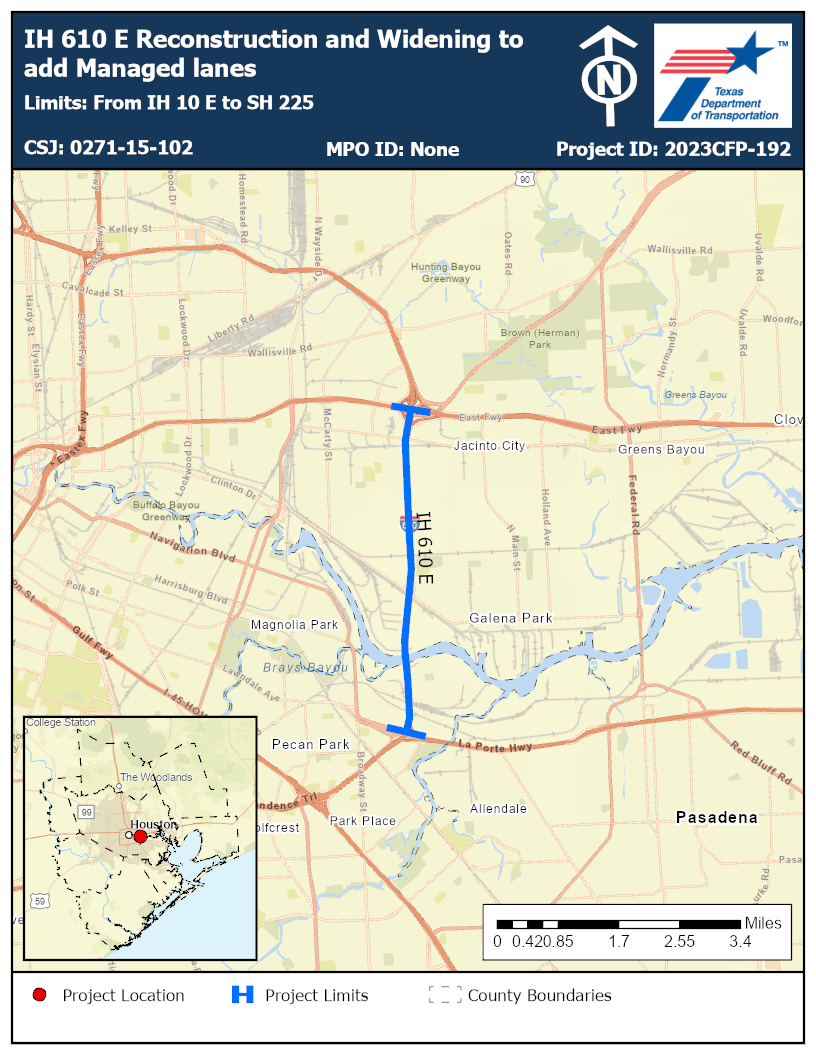

Project Title | IH 610 E Reconstruction and Widening to add Managed lanes |
Facility/Street/Highway | IH 610 E |
Limits | From IH 10 E to SH 225 |
Description | RECONSTRUCT AND WIDEN FROM 8 TO 12 LANE (ADD 4 MANAGED LANES) - Safety, operational and mobility improvements to the IH 610 E mainlanes and frontage roads, based on results of the SH 225 PEL/IH 610 East PEL study |
Timeframe | Medium Term (6-10 Years) |
Estimated Cost | $150,000,000.00 |
Investment Category-Focused Criteria
Yes
H-GAC 2023 Regional Goods Movement Study
https://engage.h-gac.com/regional-goods
Medium
Yes
8.9
12.0%
Yes
Yes
0.00
The project consists of reconstructing and widening IH 610 E in Harris County from 8 to 12 lanes, adding 4 managed lanes (2 in each direction). The project spans along IH 610 E from SH 225 to IH 45 S. It includes safety, operation, and mobility improvements to IH 610 E main lanes and frontage roads, based on the results of the SH 225 PEL/IH 610 East Planning and Environmental Linkage (PEL) study. In addition to the reconstructing and widening of the existing roadway, the project will include improvements to drainage and pavement conditions of the roadway, as well as bicycle and pedestrian improvements in the corridor. IH 610 E is one of three large routes crossing over the Buffalo Bayou that connects IH 45 S to IH 10 E directly, both of which are classified as a major hurricane evacuation route. IH 610 also serves as an important link on the Critical Urban Freight Network, as it sits on both the National Highway Freight Network and the Texas Highway Freight Network. This segment is used by Harris County Transit’s Baytown/La Porte – Gulfgate Shuttle, which can use the managed lanes to increase reliability of service. The purpose of the project is to reduce crashes, improve connectivity, and ease congestion on this segment of UH 610. This improvement, in conjunction with the other adjacent proposed improvements, will improve freight access to many major freight generators in the region including the region’s seaports, airports, manufacturing facilities and many freight warehouses. The project will improve operations for the regional network by reducing congestion on IH 610 E and improving the connections between other parts of the freeway network. The roadway improvement for IH 610 will improve operations for the express services that use the link and connect to other parts of the region. As required by state design guidelines, the capacity increase will also be balanced with improvements to improvements to the pedestrian and bicycle facilities in the corridor. The added capacity will improve regional connectivity for all modes while also improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment of IH 10 E up to TxDOT and FHWA safety standards. The enhanced drainage system that results from the reconstruction will improve regional resilience by reducing the risk of flooding on this critical freeway link.
No
No
No
Yes
IH 610 E is 1 of 3 large routes crossing over the Buffalo Bayou (Others being BW 8 and SH 146) that connects to IH 10 E directly which is classified as a State Evacuation route.
Other Investment Category Focused Criteria
This section of IH 610 is heavily congested and in need of additional capacity to improve freight fluidity. In TTI’s 2022 100 Most Congested Roadways in Texas Report, the project roadway segment was ranked 78th in all delays and 55th in truck delay. The annual total delay per mile on the segment is 139,202 person hours, and truck delay is 11,777 person hours. The current daily volume of traffic on the segment is roughly 131,443 vehicles per day, of which 8.9 percent are trucks. Volume is estimated to increase by 40 percent by 2041, 12% of which is projected to be trucks. The added capacity will improve regional connectivity for all modes while also reducing congestion and improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment of IH 610 E up to TxDOT and FHWA safety standards.
A reconstructed IH 610 E (Clinton Drive)/intersection leads to more Port of Houston facilities and High Level Rd industries/warehouses along Buffalo Bayou. Port Houston Barbour’s Cut Terminal is projected to have 8.5 million truck trips per year by the year 2045 with Port Houston expecting to invest over half a billion dollars into the Barbour’s Cut Terminal over the next 10 years. The potential managed lanes along IH 610 E could provide opportunities for express freight trips.
Currently, the study area does not support opportunities for bicycle and pedestrian facilities with discontinuous frontage roads and lack of sidewalks. The City of Houston's Bike plan does not propose any bike routes along our study area. Potentially reconstructing the roadways to current standards could provide an opportunity to design continuous frontage roads to promote pedestrian/bicycle connectivity and widen sidewalks to accommodate shared use path facilities where appropriate.
Currently, METRO only services a limited area along IH 610 E with 3 lines: Broadway, Manchester, and Ella Clinton but not on the IH 610 E main lanes. There are limited facilities within the PEL study area to take people from the study area to the greater Houston area. The potential recommended managed lanes along the roadways could provide opportunities to implement bus rapid transit or high occupancy vehicle travel to the greater Houston area.
?The project will add lanes and improve the shoulders to allow more space to move disabled vehicles and to better maintain flow on the facility vehicle collisions. This bridge is 1 of 3 major crossings over the Buffalo Bayou, but the other 2 are miles to the east adding travel time and emissions to the region if IH 610 E was to be shut down. This bridge will be raised higher to avoid ship strikes that could close the bridge for a period of time to perform inspections and at the same time this bridge segment is being raised it will replace the IH 610 E underpass location at Clinton Drive that went under water during the City of Houston 96 inch water transmission main pipe burst event on Feb 27, 2020 which closed IH 610 E for many hours.
The pavement condition on the segment is largely in fair to poor condition, with an International Roughness Index (IRI) score of between 95 and 170 (fair) or over 170 (poor). The bridge going over Buffalo Bayou is in poor condition according to the FHWA’s guidelines, with a condition score of 4. The project will bring the roadway and bridge to FHWA and TxDOT standards. This will lead to an improvement in the state of good repair and extend the service life of the facility. Reconstructing the roadway to current standards could provide an opportunity to increase the pavement thickness to accommodate constant heavy freight traffic for long periods of time.
Planning Factors Criteria
0.72
3.27
The crash rate on this segment is 281.56 crashes per 100 million vehicle miles traveled, higher than the statewide average for similar roadway types, 218.68. The serious injury rate (9.88) is also much higher than the statewide average (5.95). The added capacity will improve regional connectivity for all modes while also improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment of IH 610 E up to TxDOT and FHWA safety standards. Reconstructing the roadway to current standards could increase shoulder widths to safely move wrecks from traffic and connect discontinuous frontage roads for bicycle and pedestrian refuge. Additionally, potential managed lanes, could move freight traffic from the main lanes to avoid collisions with passenger vehicles or vice versa. Ultimately, either option would allow for wider lanes, separate lanes, and wider shoulders for vehicles to comfortably drive next to each other.
Resiliency
High
Medium
According to the H-GAC Regional Resilience Tool, this roadway is rated as having high vulnerability to flooding. The enhanced drainage system that results from the reconstruction will improve regional resilience by reducing the risk of flooding on this critical link. All current projects are being designed to meet and/or exceed ATLAS-14 drainage standards. Raising the bridge to 170 feet (same height as the future SL 8 bridge) replaces the IH 610 E underpass location at Clinton Drive that went under water during the City of Houston 96 inch water transmission main pipe burst event on Feb 27, 2020 with an overpass.
Access/Connectivity
14,031
16,256
Yes
Yes
Yes
Environmental Justice
14,031
16,256
4,731
1787
773
2730
69.20
The project is centrally located in the regional network and will produce improvements in mobility and connectivity for vulnerable populations as well as connectivity to jobs, schools, medical facilities, and social services for the regional population. Potentially reconstructing the roadway to current standards could provide opportunities for more access and connectivity through improving bicycle, pedestrian, and transit facilities to connect those without vehicles to their desired destinations. Potential recommends projects that will provide opportunities to connect the communities through landscaping beautification and roadway aesthetics that highlight the communities of the corridor.
This project is providing drainage improvements that meet or exceed ATLAS-14 standards (reduced flooding risk). If sound walls are found to be needed, they will be constructed as part of this project. The SH 225 and IH 610 E PEL Study will include an evaluation of the environmental constraints to avoid or mitigate potential impacts that can be transferred into potential projects. The purpose of the PEL study is to reach EJ populations early on to collect their input to potentially incorporate into possible projects. Potentially reconstructing the roadway to current standards could provide opportunities for more access and connectivity through improving bicycle, pedestrian, and transit facilities to connect those without vehicles to their desired destinations. Potential projects could provide opportunities to connect the communities through landscaping beautification and roadway aesthetics that highlight/tie the communities of the corridor.
Impacts on Natural and Cultural Resources
There are no cultural resources nearby this project. Clinton Park (natural) should be unimpacted by this project as it is too far east of this project. The Gerhart-Pugh Family cemetery adjacent to IH 610 E should be avoided. The SH 225 and IH 610 E PEL study will include an evaluation of the environmental constraints associated with avoiding historical landmarks and sites, cemeteries, and endangered species to transfer to potential projects.
H-GAC Staff, Please calculate Emissions reductions for us per email instructions 4/26/23.
Innovation
Yes
The project will implement new infrastructure technologies to enhance accessibility, mobility, multimodalism, resiliency, reliability, and traffic operations and will implement new autonomous/ connected vehicle technology. Brand new Signal Phasing and timing (SpAT) signals will be installed on this segment of the project (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads). This simply broadcasts red, gree,n and yellow times ahead of signalized intersections to connected vehicles newer than model year 2021 or if you have the apps (Traffic Safely and ConnectSmart) downloaded on your cell phone for older vehicles. This provides ample time for you to slow down before intersections because of the timing and to adequately adjust with flow of traffic- platooning. The advantages are improved safety because of a reduction of red-light-running crashes and carbon emission reductions resulting from better traffic platooning. While it might be part of CSJ 701 right now, this type of work could easily be done on these construction/reconstruction projects.
Yes
The project will implement new infrastructure technologies to enhance accessibility, mobility, multimodalism, resiliency, reliability, and traffic operations and will implement new autonomous/ connected vehicle technology. Brand new Signal Phasing and timing (SpAT) signals will be installed on this segment of the project (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads). This simply broadcasts red, green, and yellow times ahead of signalized intersections to connected vehicles newer than model year 2021 or if you have the apps (Traffic Safely and ConnectSmart) downloaded on your cell phone for older vehicles. This provides ample time for you to slow down before intersections because of the timing and to adequately adjust with flow of traffic- platooning. The advantages are improved safety because of a reduction of red-light-running crashes and carbon emission reductions resulting from better traffic platooning. While it might be part of CSJ 701 right now, this type of work could easily be done on these construction/reconstruction projects.
