Regional Goods Movement Questionnaire
Project Information
Agency Name | TxDOT Houston District |
Project Title | SH 225 Widening/Operational Improvements |

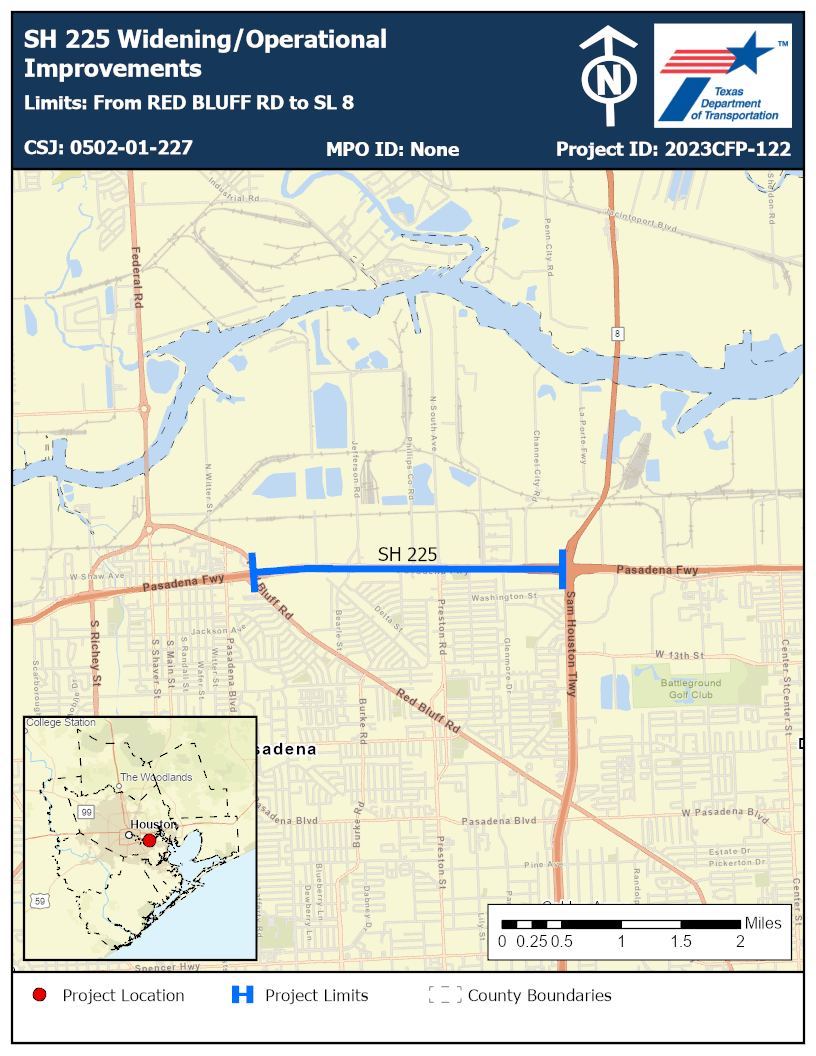

Facility/Street/Highway | SH 225 |
Limits | From RED BLUFF RD to SL 8 |
Description | RECONSTRUCT AND WIDEN FROM 6 TO 12 LANE (ADD 2 GENERAL PURPOSE LANES AND 4 MANAGED LANES) - Safety, operational and mobility improvements to SH 225 mainlanes and frontage roads, based on results of the SH 225 PEL/IH 610 East PEL study |
Timeframe | Medium Term (6-10 Years) |
Estimated Cost | $146,400,000.00 |
Investment Category-Focused Criteria
No
Yes
20.8
32.4
Yes
Yes
100,000,000 Plus
The project consists of reconstructing and widening SH 225 from 6 to 12 lanes, spanning from Red Bluff Road to SL 8. The project includes adding 2 general purpose lanes (1 in each direction) and 4 managed lanes (2 in each direction). It also includes safety, operational, and mobility improvements to the SH 225 main lanes and frontage roads. The project improvements were developed based on the preliminary results of the SH 225 PEL/IH 610 E PEL study. The project will include measures for crash reduction and improved safety, greater accessibility and connectivity, and congestion relief. In addition to the reconstruction and widening of the existing roadway, the project will include improvements in the safety, drainage, pavement condition, and bridge condition. The purpose of this project is to increase safety, improve connectivity, and reduce delay on this segment of SH 225. It will improve freight fluidity by connecting refineries and manufacturing plants to the Port of Houston wharfs along Buffalo Bayou. The project will improve operations for the regional network by reducing congestion on SH 225 and improving the connections between other parts of the freeway network. As required by state design guidelines, the capacity increase will also be balanced with improvements to the pedestrian and bicycle facilities in the corridor if right of way width allows. The added capacity will improve regional connectivity for all modes while also improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment of SH 225 up to TxDOT and FHWA safety standards. The enhanced drainage system that results from the reconstruction will improve regional resilience by reducing the risk of flooding on this critical freeway link. Because of its central location in the regional network, the project will also produce improvements in mobility and connectivity for vulnerable populations as well as connectivity to jobs, schools, medical facilities, and social services for the regional population.
No
No
No
Yes
SH 225 runs parallel to IH 10 E which is a state evacuation route, also connects directly to SH 225 and SH 146 portions that are a State evacuation route.
Other Investment Category Focused Criteria
This section of SH 225 is congested and in need of additional capacity. According to TTI’s 2022 100 Most Congested Roadways in Texas Report, the project is ranked 80th in truck delay. The annual total delay per mile on the segment is 57,307 person-hours, and truck delay is 8,355 person-hours. The current daily volume of traffic on the segment is roughly 101,859 vehicles per day, of which 19.7 percent are trucks. It is estimated that volume will increase 40 percent by 2041. For SH 225, traffic operates at LOS D near Beltway 8 in the eastbound direction during the AM peak hour and in the westbound direction during the PM peak hour. Traffic operations on SH 225 between IH 610 E and Beltway 8 are generally LOS D in both directions during both AM and PM peak hours but experience LOS E operations by the I-610E interchange. To mitigate worsening traffic operations, managed lanes to accommodate the projected increases in passenger and commercial vehicles would be constructed.
The project takes place in Harris County in a high growth area. For example, Port Houston Barbour’s Cut Terminal is projected to have 8.5 million truck trips per year by the year 2045 with Port Houston expecting to invest over half a billion dollars into the Barbour’s Cut Terminal over the next 10 years. There are also multiple existing warehouses/plants and many new developments planned are on this segment of SH 225, which are generating large volumes of truck traffic. Additional lanes will relieve congestion and increase reliability of the FHWA freight network. The potential managed lanes along SH 225 could provide opportunities for express freight trips.
Currently, the PEL study area does not support opportunities for bicycle and pedestrian facilities with discontinuous frontage roads and lack of sidewalks. The City of Houston's Bike plan does not propose any bike routes along our study area. Reconstructing the roadways to current standards could provide an opportunity to design continuous frontage roads to promote pedestrian/bicycle connectivity and widen sidewalks to accommodate shared use path facilities where appropriate.
Harris County Transit: Baytown/Laporte - Gulfgate Shuttle uses this route on SH 225 and could use the managed lanes to increase reliability of this service. They also provide on-demand services throughout SH 225. There are limited facilities within the PEL study area to take people from the study area to the greater Houston area. The potential recommended managed lanes along the roadways could provide opportunities to implement bus rapid transit or high occupancy vehicle travel to the greater Houston area.
The project will add lanes and improve the shoulders to allow more space to move disabled vehicles and to better maintain flow on the facility vehicle collisions. Given this project’s location and SH 225’s location, a backup route can be easily found if SH 225 is ever shut down, for example IH 10 E or SH 225 frontage roads and numerous city streets that run east-west could be used and thus minimizing the impact of an inoperability period.
Some sections on the project segment are in poor condition (with an International Roughness Index (IRI) score of over 170). The bridges along the segment are in fair condition (a minimum condition rating of 5-6 according to FHWA guidelines). The reconstruction and widening project will bring them up to today’s TxDOT and FHWA design standards. This will improve the overall state of good repair of the network and extend the service life of the facility. Reconstructing the roadway to current standards could provide an opportunity to increase the pavement thickness to accommodate constant heavy freight traffic for long periods of time.
Planning Factors Criteria
1.26
6.31
The crash rate on this corridor is 291.26 crashes per 100,000,000 vehicle miles traveled. This is higher than the average for similar roadways, which is 220.23. The fatality rate for the segment is 1.26 and the serious injury rate is 6.31. The serious injury rate is higher than the statewide serious injury average of 5.95. The added capacity will improve regional connectivity for all modes while also improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment up to TxDOT and FHWA safety standards. Reconstructing the roadway to current standards could increase shoulder widths to safely move wrecks from traffic and connect discontinuous frontage roads for bicycle and pedestrian refuge. Additionally, managed lanes could move freight traffic from the main lanes to avoid collisions with passenger vehicles or vice versa. Ultimately, either option would allow for wider lanes, separate lanes, and wider shoulders for vehicles to comfortably drive next to each other.
Resiliency
Medium
Medium
Reducing the risk of collision for freight vehicles, especially HAZMAT loads has a direct impact on the facility and surrounding community resilience by mitigating potential for HAZMAT collisions. The enhanced drainage system that results from the reconstruction will improve regional resilience by reducing the risk of flooding on this critical freeway link. All current projects are being designed to meet and/or exceed ATLAS-14 drainage standards.
Access/Connectivity
7,341
10,236
Yes
Yes
No
Environmental Justice
7,341
10,236
2,448
807
147
1553
38.80
Because of the project’s central location in the regional network, the project will also produce improvements in mobility and connectivity for vulnerable populations as well as connectivity to jobs, schools, medical facilities, and social services for the regional population. Reconstructing the roadway to current standards could provide opportunities for more access and connectivity through improving bicycle, pedestrian, and transit facilities to connect those without vehicles to their desired destinations. Potential recommended projects that will provide opportunities to connect the communities through landscaping beautification and roadway aesthetics that highlight the communities of the corridor.
The SH 225 and IH 610 E PEL Study will include an evaluation of the environmental constraints to avoid or mitigate potential impacts that can be transferred into potential projects. The purpose of the PEL study is to reach EJ populations early on to collect their input to potentially incorporate into possible projects. Potentially reconstructing the roadway to current standards could provide opportunities for more access and connectivity through improving bicycle, pedestrian, and transit facilities to connect those without vehicles to their desired destinations. Potential projects could provide opportunities to connect the communities through landscaping beautification and roadway aesthetics that highlight/tie the communities of the corridor.
Impacts on Natural and Cultural Resources
The SH 225 and IH 610 E PEL study will include an evaluation of the environmental constraints associated with avoiding historical landmarks and sites, cemeteries, and endangered species to transfer to potential projects before this project lets to construction.
H-GAC Staff, Please calculate Emissions reductions for us per email instructions 4/26/23
Innovation
Yes
The project will implement new infrastructure technologies to enhance accessibility, mobility, multimodalism, resiliency, reliability, and traffic operations and will implement new autonomous/ connected vehicle technology. Brand new Signal Phasing and timing (SpAT) signals will be installed on this segment of the project (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads). This simply broadcasts red, green, and yellow times ahead of signalized intersections to connected vehicles newer than model year 2021 or if you have the apps (Traffic Safely and ConnectSmart) downloaded on your cell phone for older vehicles. This provides ample time for you to slow down before intersections because of the timing and to adequately adjust with flow of traffic- platooning. The advantages are improved safety because of a reduction of red-light-running crashes and carbon emission reductions resulting from better traffic platooning.
Yes
The project will implement new infrastructure technologies to enhance accessibility, mobility, multimodalism, resiliency, reliability, and traffic operations and will implement new autonomous/ connected vehicle technology. Brand new Signal Phasing and timing (SpAT) signals will be installed on this segment of the project (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads). This simply broadcasts red, green, and yellow times ahead of signalized intersections to connected vehicles newer than model year 2021 or if you have the apps (Traffic Safely and ConnectSmart) downloaded on your cell phone for older vehicles. This provides ample time for you to slow down before intersections because of the timing and to adequately adjust with flow of traffic- platooning. The advantages are improved safety because of a reduction of red-light-running crashes and carbon emission reductions resulting from better traffic platooning.
