Regional Goods Movement Questionnaire
Project Information
Agency Name | TxDOT Houston District |
Project Title | SH 288 Widening |

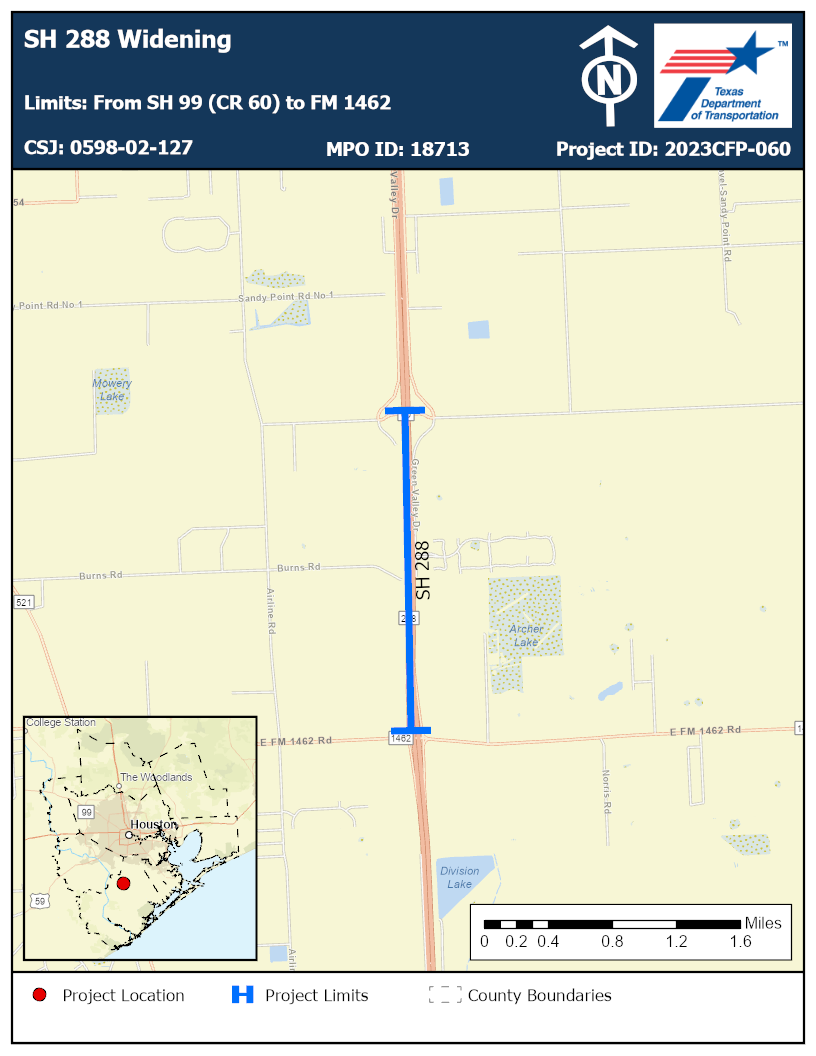

Facility/Street/Highway | SH 288 |
Limits | From SH 99 (CR 60) to FM 1462 |
Description | Reconstruct and widen from 4-lanes to 6-lanes. The proposed project will widen to the inside, adding two additional lanes (one in each direction), along with turn lanes at select locations. It will provide drainage for stormwater to accommodate the additional pavement. Frontage roads are not included in this project. |
Timeframe | Medium Term (6-10 Years) |
Estimated Cost | $56,300,000.00 |
Investment Category-Focused Criteria
Yes
H-GAC 2023 Regional Goods Movement Study
https://engage.h-gac.com/regional-goods
High
Yes
12.1%
17.1%
Yes
No
Description: The project consists of reconstructing and widening a segment of SH 288 from 4-lanes to 6-lanes from SH 99 (CR 60) to FM 1462 in a critical and high growth area in Brazoria County. The proposed project helps connect two urbanized areas and is a critical evacuation route for the southern region and coastal areas. The proposed project will widen to the inside, adding two additional lanes (one in each direction), along with turn lanes at select locations to accommodate future growth in the area. Improvements will provide drainage for stormwater to accommodate the additional pavement and maintain flooding vulnerability at low to moderate levels. In addition to the reconstruction and widening of the exiting roadway, the project will include improvements in the safety, capacity, drainage, resiliency and flood mitigation, pavement condition, bridge condition, and bicycle and pedestrian improvements per state and federal standards. This segment of SH 288 is a hurricane evacuation route and provides an evacuation route to minority populations directly adjacent to the corridor. This segment also provides an evacuation route to minority, zero vehicle households, female head of household, and elderly populations south of the project and in coastal areas. SH 288 is ranked moderate and high in vulnerability score for flooding and storm surge, respectively. The project is ranked as “Medium Priority” project in the 2023 H-GAC Regional Goods Movement Plan and is listed in the H-GAC RTP (MPOID 18713). The project segment is an essential link on the Texas Highway Freight Network (THFN) and is part of H-GAC’s Critical Urban Freight Network for the region. It is identified as “High Priority” in the H-GAC 2023 Regional Goods Movement Plan and included in the RTP (MPOID 18713). The project will increase freight reliability to the Port of Freeport. Need: The current traffic volume on the segment is 41,000 vehicles per day of which 12.1 percent is truck traffic. By 2041, the daily volume is expected to grow to 57,400 vehicles – a 40 percent increase, and truck traffic is expected to account for 17.1 percent. In TTI’s 2022 100 Most Congested Roadways in Texas Report congestion data, the segment’s annual total delay per mile on the segment was 920 person hours and truck delay was 566 person hours. The total crash rate for all crash types over the past five years was 44.03 crashes per 100 million vehicle miles and the fatal crash rate was 0.72. There are several pavement sections and at least two bridges on the segment that are in fair condition (with conditions scores of 5 and 6) and could use improvements. The reconstruction will bring the pavement and bridges up to good condition and extend the service life of the facility. Purpose and Contribution: In addition to the reconstruction and widening of the exiting roadway, the project will include improvements to safety, drainage, and pavement conditions. New ITS projects are being proposed on another project, CSJ ID 0598-02-120/ MPOID 17090, for this same location and could be constructed during this same timeframe. The added capacity will improve regional connectivity for all modes while also improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment of SH 288 up to TxDOT and FHWA safety standards.
No
Yes
Other Investment Category Focused Criteria
The current traffic volume on the segment is 41,000 vehicles per day of which 12.1 percent is truck traffic. By 2041, the daily volume is expected to grow to 57,400 vehicles (40% increase), and truck traffic is expected to account for 17.1 percent. In TTI’s 2022 100 Most Congested Roadways in Texas Report congestion data, the segment’s annual total delay per mile on the segment was 920 person hours and truck delay was 566 person hours. Improvements in safety, capacity, and crash reduction, as well as improving the area’s accessibility and connectivity, should improve daily traffic operations.
Numerous new subdivisions and retail areas are being built along the vicinity of SH 288 between Pearland and Lake Jackson generating new traffic, which will benefit from the project. The proposed project helps connect two urbanized areas, Lake Jackson-Angleton UA to Houston’s LUA, as well as provides a critical evacuation route for the Lake Jackson-Angleton UA.
This project reconstructs the roadways to current standards and provides opportunities to design continuous frontage roads to promote pedestrian/bicycle connectivity and widens sidewalks to accommodate shared use path facilities where appropriate.
There are no transit services currently operating on SH 288, but future service could use the main lanes (and/or frontage roads).
The project will add lanes and improve the shoulders to allow more space to move disabled vehicles and to better maintain flow on the facility vehicle collisions.
There are several pavement sections and bridges on the segment that are in fair condition and could use improvement. The reconstruction will bring the pavement and bridges up to good condition and extend the service life of the facility.
Planning Factors Criteria
0.72
2.17
The total crash rate for all crash types over the past five years was 44.03 crashes per 100 million vehicle miles and the fatal crash rate was 0.72. The added capacity will improve regional connectivity for all modes while also improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment up to TxDOT and FHWA safety standards.
Resiliency
Medium
Low
The enhanced drainage system that results from the reconstruction will improve regional resilience by reducing the risk of flooding on this critical freeway link. All current projects are being designed to meet and/or exceed ATLAS-14 drainage standards.
Access/Connectivity
5,839
11,749
No
No
Yes
Environmental Justice
5,839
11,749
1,066
1152
629
1449
34.60
Because of its central location in the regional network, the project will also produce improvements in mobility and connectivity for vulnerable populations as well as connectivity to schools, medical facilities, and social services for the regional population. These proposed improvements provide an evacuation route to minority populations directly adjacent to the corridor. This segment also provides an evacuation route to minority, zero vehicle households, female head of household, and elderly populations south of the project and close to the coast. SH 288 is ranked moderate and high in vulnerability score for flooding and storm surge, respectively.
All current projects are being designed to meet and/or exceed ATLAS-14 drainage standards (reduce flooding). Any sound walls that are identified prior or during the National Environmental Policy Act (NEPA) process will be constructed on this project, otherwise the corridor is mostly in a rural area and vacant land uses with a few residential developments emerging along the current segment.
Impacts on Natural and Cultural Resources
No Cultural or Natural resources that could be impacted have been identified on this segment at this time.
H-GAC Staff, Please calculate Emissions reductions for us per email instructions 4/26/23
Innovation
Yes
The project will implement new infrastructure and autonomous/ connected vehicle technology to enhance accessibility, mobility, multimodalism, resiliency, or reliability, or traffic operations. Brand new Signal Phasing and timing (SpAT) signals will be installed on this segment of the project (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads). This simply broadcasts red, green, and yellow times ahead of signalized intersections to connected vehicles (model year 2021 or newer) or if you have the apps (Traffic Safely and ConnectSmart) downloaded on your cell phone for older vehicles. This provides ample time for you to slow down before intersections because of the timing and also to adequately adjust with flow of traffic- platooning. The advantages are improved safety because of a reduction of red-light-running crashes and carbon emission reductions resulting from better traffic platooning.
Yes
The project will implement new autonomous/ connected vehicle technology. Brand new Signal Phasing and timing (SpAT) signals will be installed on this segment of the project (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads). This simply broadcasts red, green, and yellow times ahead of signalized intersections to connected vehicles (model year 2021 or newer) or if you have the apps (Traffic Safely and ConnectSmart) downloaded on your cell phone for older vehicles. This provides ample time for you to slow down before intersections because of the timing and also to adequately adjust with flow of traffic- platooning. New ITS improvements are being proposed on another project, CSJ ID 0598-02-120/ MPOID 17090, for this same location and could be constructed during this same timeframe.
