Regional Goods Movement Questionnaire

Project Information

Agency Name TxDOT Houston District
Project Title SH 288 Widening

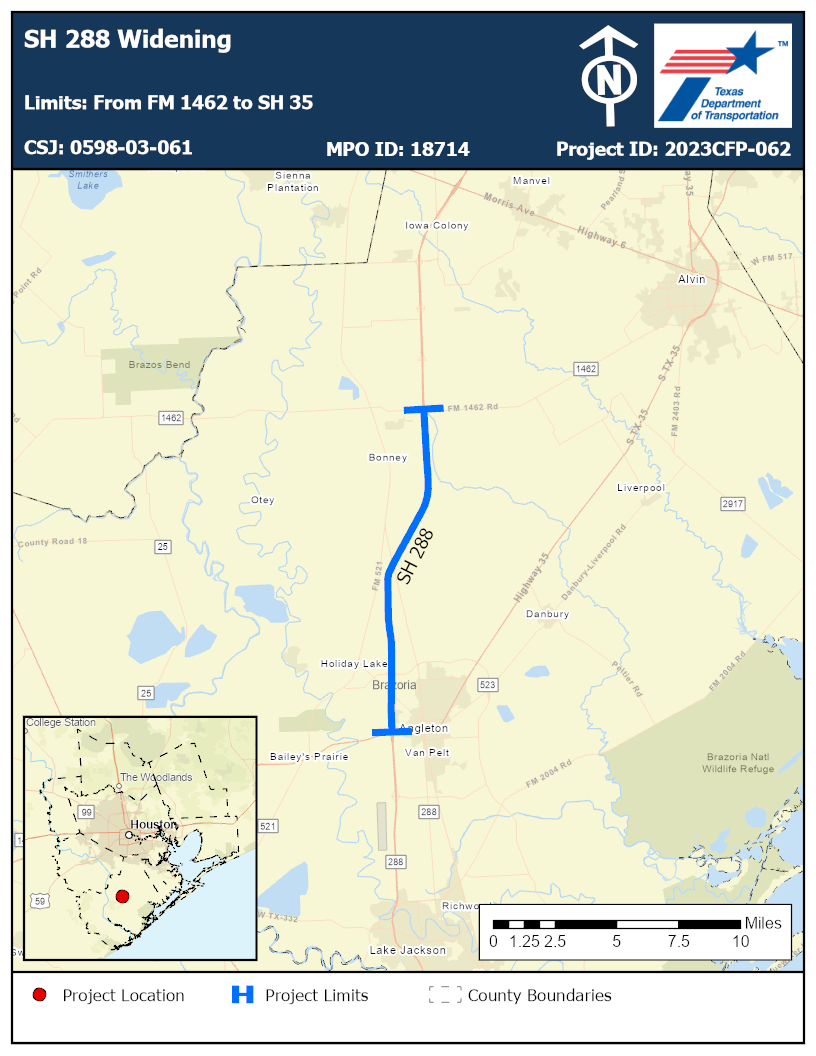

Facility/Street/Highway SH 288
Limits From FM 1462 to SH 35
Description Reconstruct and widen from 4-lanes to 6-lanes. The proposed project will widen to the inside, adding two additional lanes (one in each direction), along with turn lanes at select locations. It will provide drainage for stormwater to accommodate the additional pavement. Frontage roads are not included in this project.
Timeframe Medium Term (6-10 Years)
Estimated Cost $351,100,000.00

Investment Category-Focused Criteria

Yes

H-GAC 2023 Regional Goods Movement Study

https://engage.h-gac.com/regional-goods

Medium

Yes

21.2%

30.0%

Yes

No

Description: The project consists of reconstructing and widening SH 288 from 4-lanes to 6-lanes from FM 1462 to SH 35 in a critical and high growth area in Brazoria County. The proposed project helps connect two urbanized areas and is a critical evacuation route for the southern region and coastal areas. The proposed project will widen to the inside, adding two additional lanes (one in each direction), along with turn lanes at select locations to accommodate future growth in the area. Improvements will provide drainage for stormwater to accommodate the additional pavement and maintain flooding vulnerability at moderate levels. As required by state and federal design guidelines, the capacity increase will also be balanced with improvements to pedestrian and bicycle facilities in the corridor. This segment of SH 288 is a hurricane evacuation route and connects to SH 6 and SL 8, also major hurricane evacuation routes. This project provides an evacuation route to minority populations directly adjacent to the corridor. This segment also provides an evacuation route to minority, zero vehicle households, female head of household, and elderly populations south of the project and in coastal areas. SH 288 is ranked moderate and high in vulnerability score for flooding and storm surge, respectively. The project is ranked as “Medium Priority” project in the 2023 H-GAC Regional Goods Movement Plan and is listed in the H-GAC RTP (MPOID 18714). The project is in a high growth area, is part of H-GAC's Critical Rural Freight Network, and is an essential link of the Texas Highway Freight Network at multiple locations. Need: This section of SH 288 connects the Port of Freeport to all points west. New, and continuing to emerge, subdivisions and retail areas built along the vicinity of SH 288 between Pearland and Lake Jackson. This new land uses are generating new traffic and necessitating added capacity. The annual daily traffic on this segment is 14,495 vehicles per day of which 21.2% are trucks. This is estimated to increase by 40% by 2041. The crash rate on the segment is 40.62 crashes per 100,000,000 vehicle miles traveled. The fatality rate of the corridor is 0.72 and the serious injury crash rate is 2.44. According to the H-GAC Resilience Tool, the project segment is moderately vulnerable to flooding and highly vulnerable to storm surge. The pavement condition on the segment is largely in fair condition, according to FHWA guidelines, with an International Roughness Index (IRI) score of between 95 and 170. Some bridges on this segment are in fair condition (condition scores of 5 or 6) according to FHWA guidelines . Purpose and Contribution: To help meet the multiple generated demands accessing the corridor, including new adjacent communities, new retail areas along the corridor, between Pearland and Lake Jackson and other traffic like truckers moving goods from/to the port. This project also will provide reliable access to the Port of Freeport by improving the capacity, connectivity, level of service, and safety of the project segment and the Critical Urban Freight Network in the region. Added capacity will improve regional connectivity for all modes while also improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment up to FHWA safety standards. The enhanced drainage system that results from the reconstruction will improve regional resilience by reducing the risk of flooding on this critical freeway link. Because of its central location in the regional network, the project will also produce improvements in mobility and connectivity as well as connectivity to schools and social services for the regional population.

No

Yes

Other Investment Category Focused Criteria

The annual daily traffic on this segment is 14,495 vehicles per day of which 21.2% are trucks. This is estimated to increase by 40% by 2041. The purpose of the project is to reduce congestion and to improve the capacity, connectivity, level of service and safety of the project segment. The added capacity will improve regional connectivity for all modes while also reducing congestion and improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment up to TxDOT and FHWA safety standards.

The project is in a high growth area of Brazoria County. This section of SH 288 connects two urbanized areas, Lake Jackson-Angleton UA to Houston’s LUA, the Port of Freeport to all points west as well as provides a critical evacuation route for the Lake Jackson-Angleton UA. New subdivisions and retail areas built along the vicinity of SH 288 between Pearland and Lake Jackson are generating new traffic and necessitating added capacity to meet these newly generated demands. The project will provide greater connectivity to new development and improve the reliability of freight movement between Houston and the Port of Freeport.

As required by state design guidelines, the capacity increase will also be balanced with improvements to improvements to the pedestrian and bicycle facilities in the corridor. This project reconstructs the roadways to current standards and provides opportunities to design continuous frontage roads to promote pedestrian/bicycle connectivity and widens sidewalks to accommodate shared use path facilities where appropriate.

There are no transit services currently operating on SH 288, but future service could use the main lanes (and/or frontage roads).

The project will add lanes and improve the shoulders to allow more space to move disabled vehicles and to better maintain flow on the facility vehicle collisions.

The pavement condition on the segment is largely in fair condition, according to FHWA guidelines, with an International Roughness Index (IRI) score of between 95 and 170. Some bridges on this segment are in fair condition according to FHWA guidelines, with a minimum condition score of 5 or 6. The project includes reconstruction which will lead to an improvement in the state of good repair and extend the service life of the facility.

Planning Factors Criteria

0.72

2.44

The crash rate on the segment is 40.62 crashes per 100,000,000 vehicle miles traveled. The fatality rate of the corridor is 0.72 and the serious injury crash rate is 2.44. The added capacity will improve regional connectivity for all modes while also improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment up to TxDOT and FHWA safety standards.

Resiliency

Medium

Low

According to the H-GAC Resilience Tool, the project segment is moderately vulnerable to flooding and highly vulnerable to storm surge. Drainage improvements will be implemented on this project to mitigate the effects of construction via detention or retention ponds. Design standards will meet and/or exceed ATLAS-14 drainage standards. The enhanced drainage system that results from the reconstruction will improve regional resilience by reducing the risk of flooding on this critical freeway link. All current projects are being designed to meet and/or exceed ATLAS-14 drainage standards. This project is on a state’s hurricane evacuation route.

Access/Connectivity

8,404

14,623

No

Yes

Yes

Environmental Justice

8,404

14,623

1,421

1966

1417

1582

30.40

The project will produce improvements in mobility and connectivity for vulnerable populations as well as connectivity to jobs, schools, medical facilities, evacuation routes, and social services for the regional population. These proposed improvements provide an evacuation route to minority populations directly adjacent to the corridor. This segment also provides an evacuation route to minority, zero vehicle households, female head of household, and elderly populations south of the project and close to the coast. SH 288 is ranked moderate and high in vulnerability score for flooding and storm surge, respectively.

All current projects are being designed to meet and/or exceed ATLAS-14 drainage standards (reduce flooding). Any sound walls that are identified prior or during the National Environmental Policy Act (NEPA) process will be constructed on this project, otherwise the corridor is mostly in a rural area and vacant land uses with a few residential developments emerging along the current segment

Impacts on Natural and Cultural Resources

No Cultural or Natural resources that could be impacted have been identified on this segment at this time.

H-GAC Staff, Please calculate Emissions reductions for us per email instructions 4/26/23.

Innovation

Yes

The project will implement new infrastructure and autonomous/connected technologies to enhance accessibility, mobility, multimodalism, resiliency, reliability, and traffic operations and will implement new autonomous/ connected vehicle technology. Brand new Signal Phasing and timing (SpAT) signals will be installed on this segment of the project (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads). This simply broadcasts red, green, and yellow times ahead of signalized intersections to connected vehicles (model year 2021 or newer) or if you have the apps (Traffic Safely and ConnectSmart) downloaded on your cell phone for older vehicles. This provides ample time for you to slow down before intersections because of the timing and to adequately adjust with flow of traffic- platooning. The advantages are improved safety because of a reduction of red-light-running crashes and carbon emission reductions resulting from better traffic platooning.

Yes

The project will implement new infrastructure and autonomous/connected technologies to enhance accessibility, mobility, multimodalism, resiliency, reliability, and traffic operations and will implement new autonomous/ connected vehicle technology. Brand new Signal Phasing and timing (SpAT) signals will be installed on this segment of the project (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads). This simply broadcasts red, green, and yellow times ahead of signalized intersections to connected vehicles (model year 2021 or newer) or if you have the apps (Traffic Safely and ConnectSmart) downloaded on your cell phone for older vehicles. This provides ample time for you to slow down before intersections because of the timing and to adequately adjust with flow of traffic- platooning. The advantages are improved safety because of a reduction of red-light-running crashes and carbon emission reductions resulting from better traffic platooning.

Additional Documents


2023HGAC-CFP-RGM-LOS-Brazoria County-Comm Pct 1 (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-City of Friendswood-Mayor (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-City of Galveston-Mayor (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-City of Pattison - Mayor (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-Port Freeport-Chairman (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-Waller County-County Judge (ALL RGM TxDOT Projects).pdf
