Regional Goods Movement Questionnaire

Project Information

Agency Name TxDOT Houston District
Project Title SS 10 Widening
Facility/Street/Highway SS 10

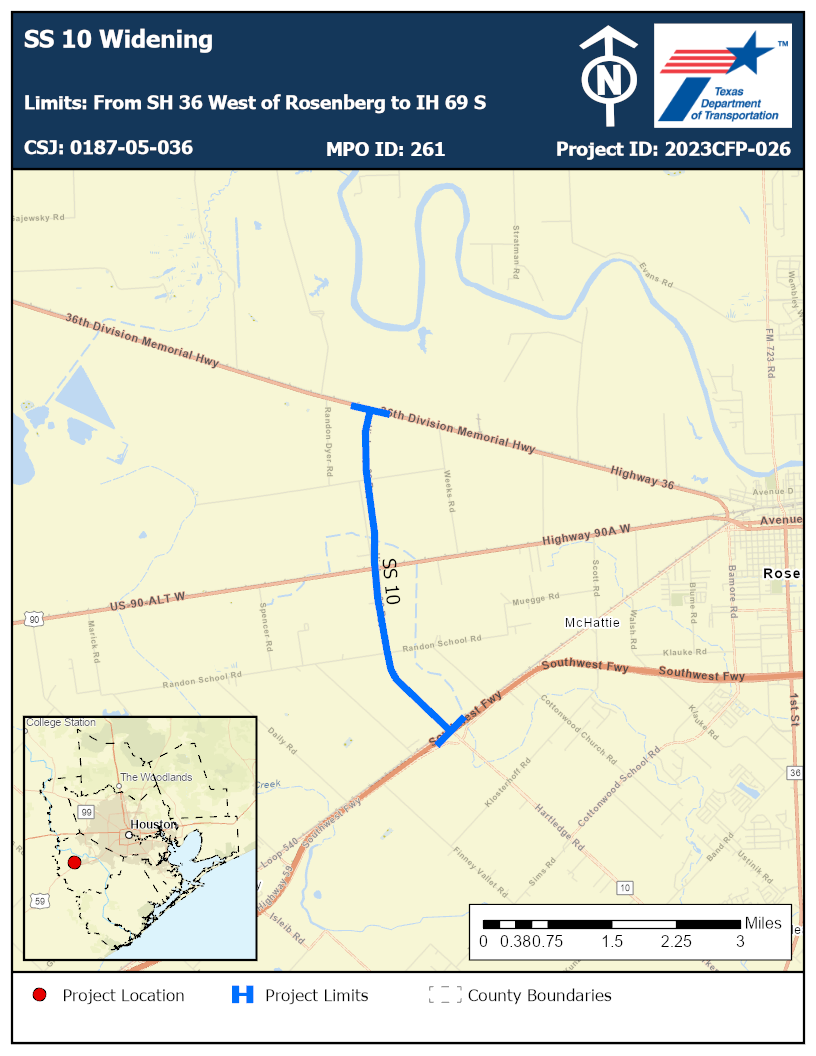

Limits From SH 36 West of Rosenberg to IH 69 S
Description WIDEN TO 4-LANE DIVIDED ROADWAY
Timeframe Medium Term (6-10 Years)
Estimated Cost $53,870,000.00

Investment Category-Focused Criteria

Yes

H-GAC 2023 Regional Goods Movement Study

https://engage.h-gac.com/regional-goods

Low

No

6.9

10.7

No

Yes

330,000 plus

The project consists of widening SS 10 to a 4-lane divided roadway in Fort Bent County from SH 36 West of Rosenberg to IH 69 S. The project is located on the Texas Highway Freight Network. The project is listed in the Fort Bend County Subregional Plan, H-GAC 2023 Regional Goods Movement Study as a Critical Urban Freight Corridor, scoring below the 4.5 threshold (MPOID 261). It is part of a larger project as well that will install ITS equipment and infrastructure to improve communication on the facility (MPOID 17100) which be constructed at the same time as this project. The project segment lies directly upon an evacuation route upon the Texas Hurricane Evacuation Network. The project will add capacity, reduce delays, and relieve congestion while increasing accessibility and connectivity. The purpose of the project is to reduce congestion on SS 10 and to improve the capacity, connectivity, level of service and safety of the project segment. The added capacity will improve regional connectivity for all modes while also improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment of SS 10 up to TxDOT and FHWA safety standards. The enhanced drainage system that results from the reconstruction will improve regional resilience by reducing the risk of flooding on this critical freeway link. This is a possible 36A corridor, which the Port of Freeport truck traffic will use as an alternative to SH 36. Because of its central location in the regional network, the project will also produce improvements in mobility and connectivity for vulnerable populations as well as connectivity to schools, medical facilities, and social services for the regional population. The project is on a state evacuation route. Multiple large (SCHC Packaging Center and Murphy Production Controls to name a few) Warehouses are located on this project segment. A railroad grade separation already exists on this segment of SS 10.

No

Yes

Other Investment Category Focused Criteria

The project consists of widening SS 10 to a 4-lane divided roadway in Fort Bent County from SH 36 West of Rosenberg to IH 69. The project is located on the TxDOT Freight Network. This section of SS 10 is congested and needs additional capacity. According to “TTI’s 2022 100 Most Congested Roadways in Texas Report,” the current daily volume of traffic on the segment is roughly 10,698 vehicles per day of which 6.9% are trucks. The estimated percent increase in volume from 2021 to 2041 is estimated to be 19,9777, a 40% increase. The total crash rate for all crash types over the past five years was 58.07 crashes per 100 million vehicle miles. The serious injury crash rate was 7.26. The added capacity will improve regional connectivity for all modes while also reducing congestion and improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment of SS 10 up to TxDOT and FHWA safety standards. Multiple intersection improvements are being constructed on this project by bringing the designs up to current standards..

This is a possible 36A corridor, which the Port of Freeport truck traffic will use as an alternative to SH 36. The project is in a High Growth Area and provides access to development of residential, retail or other land uses. This segment of SS 10 will match the already widened 4 lane section of SS 10 to the southeast, which has a Dollar Tree Distribution center fronting on it.

As required by state design guidelines, the capacity increase will also be balanced with improvements to improvements to the pedestrian and bicycle facilities in the corridor. Sidewalks will be built on the IH 69 S frontage roads developed by this project.

No existing or planned transit service is provided on this facility.

In expanding the roadway into a 4-Lane divided, it will allow more space to move disabled vehicles and to better maintain flow on the facility vehicle collisions. In the event SS 10 is shut down, traffic will have to reroute way out of their way to take SH 36 through downtown Rosenberg as an alternative route to reach SH 36.

Segments of the project have pavement and bridges in “fair” or worse condition. The project includes reconstruction of the roadway which will lead to an improvement in the state of good repair and extend the service life of the facility. The bridge (built in 1999 and has a sufficiency rating of 86.9) over Coon Creek will also get reconstructed and widened.

Planning Factors Criteria

0

7.26

All current projects are being designed to meet and/or exceed current FHWA safety standards. A divided grass median will be constructed with this project with the opportunity for a cable barrier to be installed in the median to prevent head on collisions.

Resiliency

Low

Low

The enhanced drainage system that results from the reconstruction will improve regional resilience by reducing the risk of flooding on this critical freeway link. All current projects are being designed to meet and/or exceed ATLAS-14 drainage standards. It is also on the state evacuation route.

Access/Connectivity

5,106

4,130

No

No

No

Environmental Justice

5,106

4,130

1,013

413

445

387

36.20

Because of its central location in the regional network, the project will also produce improvements in mobility and connectivity for vulnerable populations as well as connectivity to jobs, schools, medical facilities, and social services for the regional population.

All current projects are being designed to meet and/or exceed ATLAS-14 drainage standards (reduce flooding). Any sound walls that are identified prior or during the National Environmental Policy Act (NEPA) process will be constructed on this project, otherwise the corridor is mostly allowing equitable access to residential and commercial land uses that front the facility. The divided medians will provide the opportunity for another agency to plant/maintain landscaping in the median to mitigate air pollution and improve aesthetic values.

Impacts on Natural and Cultural Resources

No Cultural resources that could be impacted have been identified on this segment at this time. During construction Best Management Practices (BMP) will be done to prevent sediment pollution in Coon Creek and any other creeks this project crosses.

H-GAC Staff, Please calculate Emissions reductions for us per email instructions 4/26/23.

Innovation

Yes

The project will implement new infrastructure technologies to enhance accessibility, mobility, multimodalism, resiliency, reliability, and traffic operations and will implement new autonomous/ connected vehicle technology. Brand new Signal Phasing and timing (SpAT) signals will be installed on this segment of the project (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads). This simply broadcasts red, green and yellow times ahead of signalized intersections to connected vehicles newer than model year 2021 or if you have the apps (Traffic Safely and ConnectSmart) downloaded on your cell phone for older vehicles. This provides ample time for you to slow down before intersections because of the timing and also to adequately adjust with flow of traffic- platooning. While it might be part of CSJ 701 right now, this type of work could easily be done on these construction/reconstruction projects.

Yes

The project will implement new infrastructure technologies to enhance accessibility, mobility, multimodalism, resiliency, reliability, and traffic operations and will implement new autonomous/ connected vehicle technology. Brand new Signal Phasing and timing (SpAT) signals will be installed on this segment of the project (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads). This simply broadcasts red, green and yellow times ahead of signalized intersections to connected vehicles newer than model year 2021 or if you have the apps (Traffic Safely and ConnectSmart) downloaded on your cell phone for older vehicles. This provides ample time for you to slow down before intersections because of the timing and also to adequately adjust with flow of traffic- platooning. While it might be part of CSJ 701 right now, this type of work could easily be done on these construction/reconstruction projects.

Additional Documents


2023HGAC-CFP-RGM-LOS-Brazoria County-Comm Pct 1 (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-City of Friendswood-Mayor (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-City of Galveston-Mayor (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-City of Pattison - Mayor (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-Port Freeport-Chairman (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-Waller County-County Judge (ALL RGM TxDOT Projects).pdf
