Regional Goods Movement Questionnaire
Project Information
Agency Name | TxDOT Houston District |

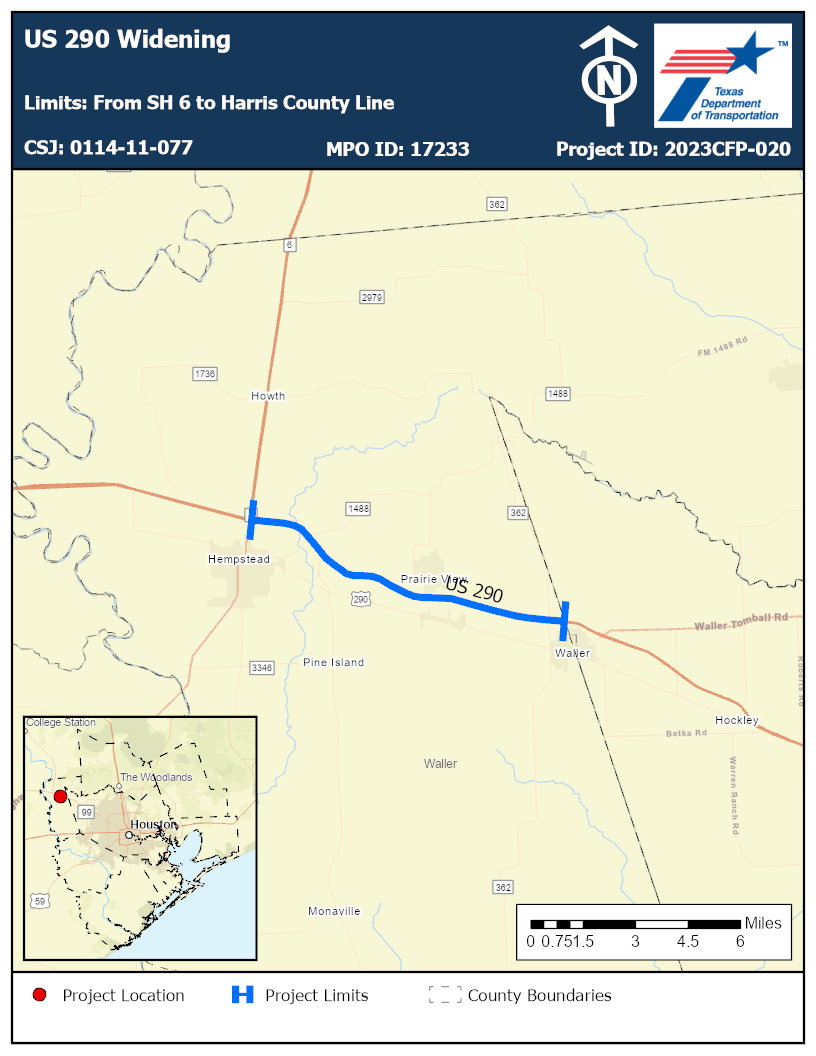

Project Title | US 290 Widening |
Facility/Street/Highway | US 290 |
Limits | From SH 6 to Harris County Line |
Description | Reconstruct and wide from 4 to 6 lanes. This project will widen the existing highway to the middle adding a third lane in each direction. |
Timeframe | Short Term (0-5 Years) |
Estimated Cost | $133,790,000.00 |
Investment Category-Focused Criteria
Yes
H-GAC 2023 Regional Goods Movement Study
https://engage.h-gac.com/regional-goods
Low
Yes
17.1
20
No
Yes
1,300,000
This project consists of reconstructing and widening US 290 in a high growth portion of Waller County from SH 6 to the Harris County Line from 4 to 6 lanes. This project will widen the existing highway to the middle adding a third lane in each direction. It is a part of the H-GAC 2023 Regional Goods Movement Study as well as the RTP 2045 (MPOID 17233), Waller County Transportation Plan, and H-GAC Prairie View Livable Center Study. In addition to the reconstruction and widening of US 290, the project will include improvements towards providing safety improvements, pedestrian and bike facilities, congestion relief, strengthening regional economic competitiveness, and added capacity. It is a part of the Critical Urban Freight Network; the project segment lies on the Texas Highway Freight Network. US 290 is also a part of the Texas hurricane evacuation route network. Colorado Valley Transit (Route Prairie View and City of Waller) provides services to Hempstead, Prairie View, and City of Waller along the US 290 corridor. In addition to widening and reconstruction, the project will include safety improvements, bike/ped facilities, drainage and flood control, and pavement and bridge rehabilitation. The purpose of the project is to reduce congestion on US 290 and to improve the capacity, connectivity, level of service and safety of the project segment and the Critical Urban Freight Network in the region. This improvement, in conjunction with others adjacent proposed, has ITS being constructed on another project (CSJ 0114-11-090/MPOID 18522) but ITS could be built at the same time as this project is constructed. The Project connects to RCR Hempstead Rail Logistics Park (recently developed - no warehouses constructed yet) at NW corner of SH 6 and US 290. There will also be logistical centers/warehouses constructed at the Beacon Hill Blvd development between FM 362 and James R. Muse Parkway (1,300,000 sq ft on the 78 acre Hines lot alone). This project will improve traffic conditions for transit users in the surrounding area. For local populations, it will increase access and connectivity to school and colleges.
No
Yes
Other Investment Category Focused Criteria
The current daily volume of traffic on the segment is roughly 43,273 vehicles per day, of which trucks represent 17.1 percent. The estimated percent increase in volume from 2021 to 2041 is estimated to be 40 percent. Added capacity from the project should improve daily traffic operations (improving freight network fluidity).
The proposed project will alleviate future congestion due to potential economic development, including expansion of warehouses. The project connects to RCR Hempstead Rail Logistics at NW corner of SH 6 and US 290. There will also be logistical centers/warehouses constructed at the Beacon Hill Blvd development between FM 362 and James R. Muse Parkway (up to 1,300,000 sq ft on the 78 acre Hines lot alone).
As required by state design guidelines, the capacity increase will also be balanced with improvements to the pedestrian and bicycle facilities in the corridor. Shared use paths will be constructed along frontage roads where they exist and right of way width allows.
Colorado Valley Transit (Route Prairie View and City of Waller) provide services to Hempstead, Prairie View, and City of Waller along the US 290 corridor. The roadway improvement for US 290 will improve operations (service reliability as well) for the transit services that use the link and connect to other parts of the region.
The project will add lanes and improve the shoulders to allow more space to move disabled vehicles and to better maintain flow on the facility during vehicle collisions. The frontage roads are noncontiguous along US 290 but BS 290 nearby (runs parallel) could act as a bypass should US 290 become inoperable.
Pavement conditions along the project route are rated Fair, and as well as a number of bridges. The project will bring the pavement and bridge conditions up to TxDOT and FHWA design standards and will improve the state of good repair of the segment and overall system.
Planning Factors Criteria
0.76
2.16
The total crash rate for all crash types over the past five years was 35.7 crashes per 100 million vehicle miles and the fatal crash rate was 0.76. The serious injury crash rate was 2.16. The project improvements will improve regional connectivity for all modes while also improving safety by reducing primary and secondary crashes and by bringing the segment up to TxDOT and FHWA safety standards. A raised center barrier will be constructed on this project which will improve safety and reduce head on collision accident possibilities.
Resiliency
Medium
Low
This project is providing drainage improvements that meet or exceed ATLAS-14 standards (reduced flooding risk). A few detention ponds and other drainage improvements will be constructed with this project.
Access/Connectivity
6,587
9,951
No
Yes
No
Environmental Justice
6,587
9,951
3,070
897
616
424
38.90
The project provides improved access to jobs and educational opportunities (such as Prairie View A&M University and SH 6 that leads to Texas A&M University in College Station) in the region. This project should not impact adjacent property owners as the need for any additional right of way (ROW) will only be needed it will be for detention ponds.
This project is providing drainage improvements that meet or exceed ATLAS-14 standards, reducing flooding risk. If sound walls (noise pollution) are found to be needed during the NEPA review process, they will be constructed as part of this project.
Impacts on Natural and Cultural Resources
As this project is widening to the center median, there should be little to no impact on the surrounding/adjacent properties whether they be culturally/naturally important. Any waterways that cross through this project will be protected during construction with Best Management Practices (BMP) to reduce sediment pollution runoff.
H-GAC Staff, please calculate Emissions reductions for us per email instructions 4/26/23.
Innovation
Yes
ITS (new DMS boards and cameras) will be constructed on CSJ ID 0114-11-090 (MPOID 18522) during this project or right after it to avoid damaging the fiber optic lines in the ground. This type of work could easily be merged and constructed during this construction project. The project will implement new infrastructure or technology to enhance accessibility, mobility, multimodalism, resiliency, reliability, or traffic operations. Brand new Signal Phasing and timing (SpAT) signals will be installed on this segment of the project (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads). This simply broadcasts red, green, and yellow times ahead of signalized intersections to connected vehicles newer than model year 2021 or if you have the apps (Traffic Safely and ConnectSmart) downloaded on your cell phone for older vehicles. This provides ample time for you to slow down before intersections because of the timing and to adequately adjust with flow of traffic- platooning. While it might be part of CSJ 701 right now, this type of work could easily be done on these construction/reconstruction projects.
Yes
The project will implement new autonomous/ connected vehicle technology. Brand new Signal Phasing and timing (SpAT) signals will be installed on this segment of the project (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads). This simply broadcasts red, green, and yellow times ahead of signalized intersections to connected vehicles newer than model year 2021 or if you have the apps (Traffic Safely and ConnectSmart) downloaded on your cell phone for older vehicles. This provides ample time for you to slow down before intersections because of the timing and to adequately adjust with flow of traffic- platooning. While it might be part of CSJ 701 right now, this type of work could easily be done on these construction/reconstruction projects.
