Regional Goods Movement Questionnaire

Project Information

Agency Name TxDOT Houston District

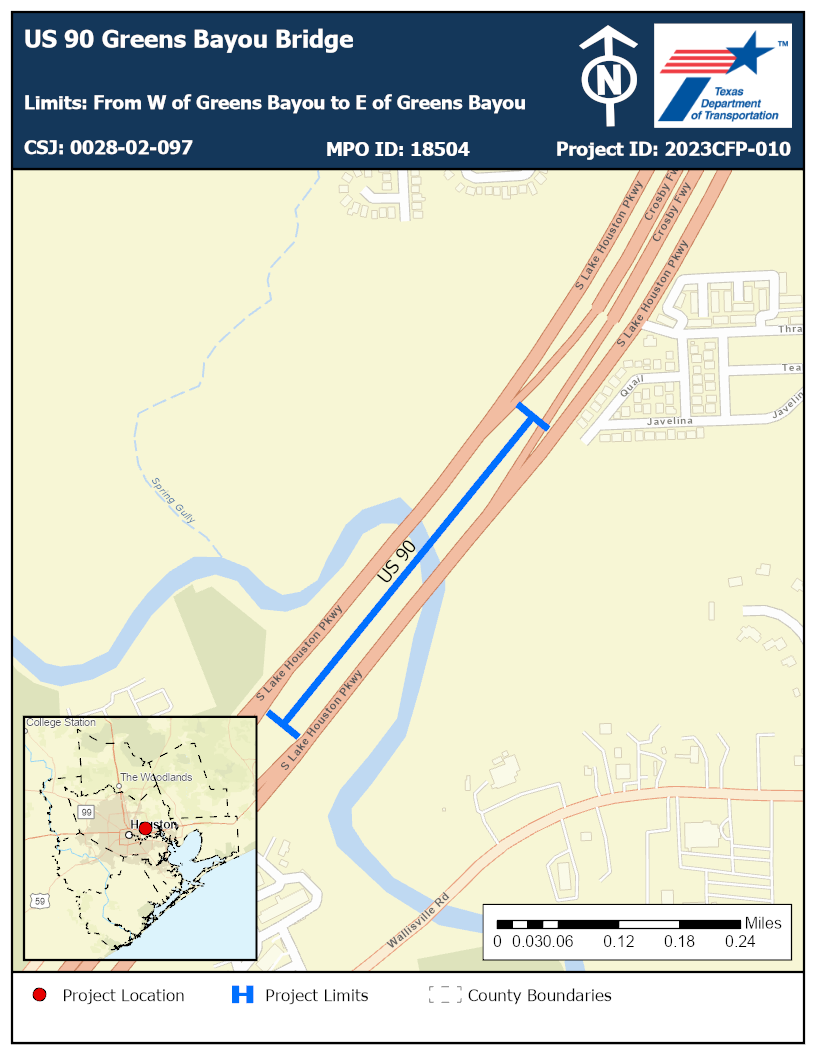

Project Title US 90 Greens Bayou Bridge
Facility/Street/Highway US 90
Limits From W of Greens Bayou to E of Greens Bayou
Description Construct bridge (6 Main Lanes) over Greens Bayou in gap of US 90 mainlanes.
Timeframe Short Term (0-5 Years)
Estimated Cost $29,100,000.00

Investment Category-Focused Criteria

Yes

H-GAC 2023 Regional Goods Movement Study

https://engage.h-gac.com/regional-goods

Medium

No

9.2%

14.2%

Yes

Yes

2,430,519

The project consists of constructing a bridge (6 main lanes) over Greens Bayou in gap of US 90 main lanes from W of Greens Bayou to E of Greens Bayou within a high growth portion of Harris County. The project is a part of the H-GAC RTP 2045 and is included in the list of RTP projects (MPOID 18504). It is identified as a “Medium Priority” project in the 2023 H-GAC Regional Goods Movement Plan. It is an essential link in the H-GAC’s Critical Urban Freight Network for the region, as it sits on the Texas Highway Freight Network. This segment of US 90 connects to SL 8 which is a Hurricane Evacuation Route. The project will include measures for resiliency and flood mitigation, accessibility, and connectivity. In addition to the construction of a bridge, the project will include improvements in safety, drainage, and pavement conditions. For this project, if the main lanes on US 90 over Greens Bayou that will grant access to the NorthPoint 90 Logistics Center (total of 2,430,519 sq ft) at Purple Sage Rd intersection that is currently under construction with some centers already completed and operational generating truck traffic. The added capacity will improve regional connectivity (improved freight network fluidity) for all modes while also improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment of US 90 up to TxDOT and FHWA safety standards. The enhanced drainage system that results from the reconstruction will improve regional resilience by reducing the risk of flooding on this critical freeway link.

No

No

No

Yes

This segment of US 90 connects to IH 8 which is a Hurricane Evacuation Route. It can also function as an alternative for IH 69 N or IH 10 E.

Other Investment Category Focused Criteria

The total crash rate for all crash types over the past five years was 80.99 crashes per 100 million. The Texas Statewide Fatality Crash Average is 1.39. The current daily volume of traffic on the segment is roughly 27,914 vehicles per day. The forecast volume for 2041 for the segment is 39,080 vehicles per day - a 40 percent increase, for which truck traffic is expected to account for 14.2 percent after implementation of the project. The purpose of the project is to reduce congestion on and to improve the capacity, connectivity, level of service and safety of the project segment and the Critical Urban Freight Network in the region. The added capacity will improve regional connectivity for all modes while also reducing congestion and improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment up to TxDOT and FHWA safety standards. With the construction of a new higher bridge over Greens Bayou compared to the existing frontage roads the flooding risk will be eliminated, thus allowing traffic flow to continue in inclement weather.

This project will finish main lanes on US 90 over Greens Bayou that will grant access to the NorthPoint 90 Logistics Center (total of 2,430,519 sq ft) at Purple Sage Rd intersection that is currently under construction with some centers already completed and operational generating truck traffic. The added capacity will improve regional connectivity for all modes while also improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment of US 90 up to TxDOT and FHWA safety standards.

Only the main lanes will be constructed on this project, no bicycle or pedestrian facilities will be constructed as part of this project.

No existing or planned transit service is provided on this facility.

If the new US 90 main lanes were to shut down, the existing frontage roads could act as an alternative route and miniziming an inoperability period. Nearby Wallisville Road could act as an alternative route as well.

The project segment has pavement in fair condition with a maximum IRI score of 138. With the construction of the new main lanes, this will change traffic patterns and shift traffic away from the existing frontage road thus extending the service life of the facility.

Planning Factors Criteria

0

0

The segment of US 90 that includes the project had a total crash rate of 80.99 crashes per 100 million vehicle miles of travel over the past five years. The bridge will improve regional connectivity for all modes while also improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment up to TxDOT and FHWA safety standards. The new bridge on this project will be designed to current FHWA and TxDOT standards.

Resiliency

Low

Low

The new US 90 Main lanes bridge will be higher than the existing frontage roads, which are more likely to be flooded by Greens Bayou. The enhanced drainage system that results from the reconstruction will improve regional resilience by reducing the risk of flooding on this critical freeway link. All current projects are being designed to meet and/or exceed ATLAS-14 drainage standards.

Access/Connectivity

6,660

8,686

No

Yes

No

Environmental Justice

6,660

8,686

2,095

804

315

1953

63.70

Because of its central location in the regional network, the project will also produce improvements in mobility and connectivity for vulnerable populations as well as connectivity to jobs, schools (IDEA Lake Houston and Purple Sage Elementary School), medical facilities, and social services for the regional population.

Reducing the risk of collision for freight vehicles, especially HAZMAT loads have a direct impact on the facility and surrounding community resilience by mitigating potential for HAZMAT collisions. All current projects are being designed to meet and/or exceed ATLAS-14 drainage standards (reduce flooding). Any sound walls that are identified prior or during the National Environmental Policy Act (NEPA) process will be constructed on this project, otherwise the corridor is mostly allowing equitable access to residential and commercial land uses that front the facility.

Impacts on Natural and Cultural Resources

No Cultural resources that could be impacted have been identified on this segment at this time. During construction Best Management Practices (BMP) will be done to prevent sediment pollution in Greens Bayou.

H-GAC Staff, Please calculate Emissions reductions for us per email instructions 4/26/23.

Innovation

Yes

This segment of US 90 is missing its ITS infrastructure and could be built/installed on another project at the same time as this project.

No

Additional Documents
