Regional Goods Movement Questionnaire

Project Information

Agency Name TxDOT Houston District
Project Title US 90 Widening

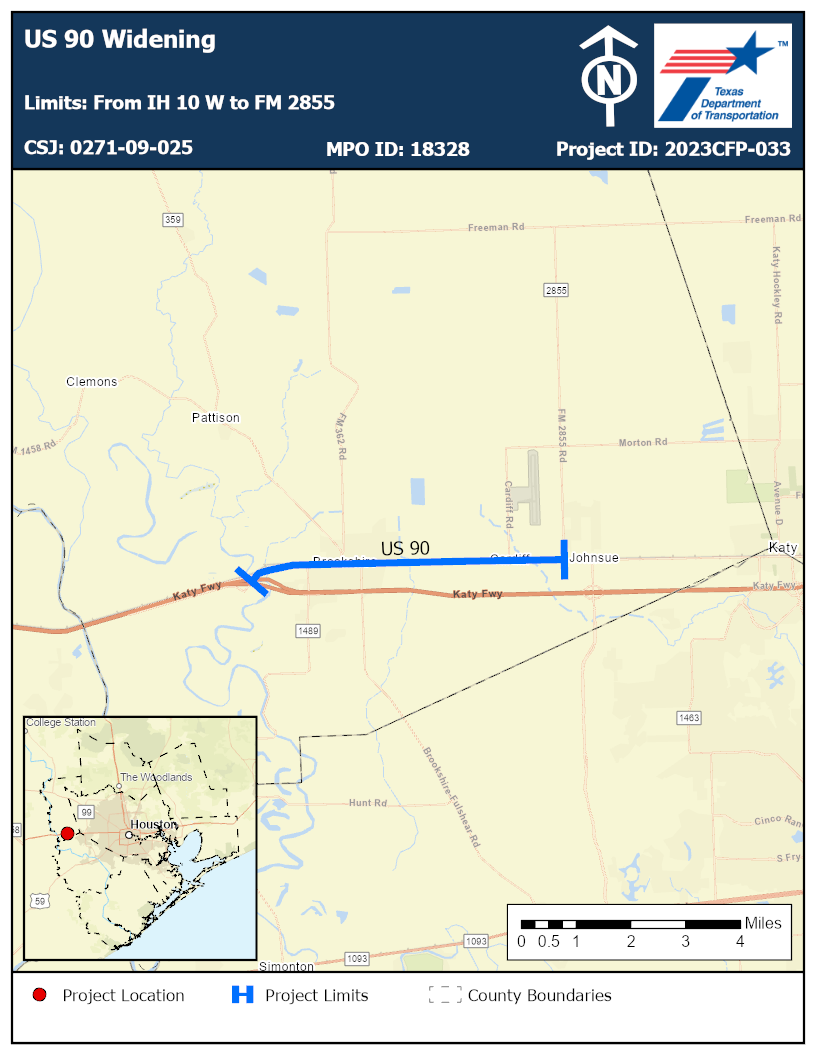

Facility/Street/Highway US 90
Limits From IH 10 W to FM 2855
Description Widen from 2-lanes to 4-lanes divided. Reconstruct highway from 2 to 4 lanes and install medians and left turn bays. Also reconstruct and widen bridges at Kellner Creek, Brookshire Creek, Willow Fork Creek, and Snake Creek. Construct pedestrian and bicycle facilities and convert the existing open-ditch drainage to a closed stormwater system.
Timeframe Medium Term (6-10 Years)
Estimated Cost $78,200,000.00

Investment Category-Focused Criteria

Yes

H-GAC 2023 Regional Goods Movement Study

https://engage.h-gac.com/regional-goods

Low

No

4.9

5.8

Yes

Yes

4,000,000 plus

The project consists of widening US 90 from 2-lanes to 4-lanes, divided from IH 10 W to FM 2855 in Waller County. The project includes reconstructing the highway from 2 to 4 lanes and installing medians and left turn bays. Additionally, reconstruction and widening of the bridges at Kellner Creek, Brookshire Creek, Willow Fork Creek, and Snake Creek are included. The project also includes construction of pedestrian and bicycle facilities and the conversion of the existing open-ditch drainage to a closed stormwater system. In addition to the reconstruction and widening of the exiting roadway, the project will include improvements in the safety, drainage, pavement condition and bridge condition on four bridges on the. The project takes place in a high growth area of Waller County. It is listed in the H-GAC 2023 Regional Goods Movement Study and H-GAC RTP (MPOID 18328). US 90 connects to IH 10 W, which is a link on the Critical Urban Freight Network, as it sits on the Texas Highway Freight Network and is a major hurricane evacuation route. The purpose of the project is to reduce congestion on US 90 and to improve the capacity, connectivity, level of service and safety of the project segment and the Critical Urban Freight Network in the region. This improvement, in conjunction with the other adjacent proposed improvements, will improve freight access to many major freight generators in the region including the region’s seaports, airports, manufacturing facilities and freight warehouses. The project connects all the warehouses in the Katy-Brookshire area north of IH 10 W and south of US 90 including but not limited to the recently constructed Empire West Business Park. The capacity increase will also be balanced with improvements to the pedestrian and bicycle facilities in the corridor. Sidewalks and/or wide shoulders/shared use paths are being constructed on this project that will enhance safety for all users. This segment of US 90 runs parallel to IH 10 W which is classified as a state evacuation route.

No

No

No

Yes

This segment of US 90 runs parallel to IH 10 W which is classified as a state evacuation route.

Other Investment Category Focused Criteria

This section of US 90 is heavily congested and needs additional capacity. According to TTI’s 2022 100 Most Congested Roadways in Texas Report, the current daily volume of traffic on the segment is roughly 7,287 vehicles per day. The estimated percent increase in volume from 2021 to 2041 is estimated to be 40 percent, with truck traffic representing 5.8 percent after project implementation. This project will construct center turn lanes and widen the road to 4 lanes. This will improve traffic flow to counter the current 2 lane traffic that impedes traffic waiting for trucks or vehicles to left turn into warehouse facilities. The purpose of the project is to reduce congestion on and to improve the capacity, connectivity, level of service and safety of the project segment and the Critical Urban Freight Network in the region. The added capacity will improve regional connectivity for all modes while also reducing congestion and improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment of up to TxDOT and FHWA safety standards. Multiple intersection improvements with turn lane improvements will be constructed as well. This project was recommended in the Waller County Mobility Plan (2019).

The project takes place in a high growth area of Waller County. It connects all the warehouses in Katy/Brookshire area north of IH 10 W/South of US 90 including, but not limited to, recently constructed Empire West Business Park. The proposed project alleviates future congestion due to potential economic development activity such as expansion of warehouses or other freight generators.

As required by state design guidelines, the capacity increase will also be balanced with improvements to improvements to the pedestrian and bicycle facilities in the corridor. There will be two 10 Ft shared use paths built on both sides of US 90 according to the schematic from March 2022.

There are no transit services currently operating on US 90, but future service could use the additional lanes in the future.

The project will add lanes and improve the shoulders to allow more space to move disabled vehicles and/or redirect traffic to better maintain flow on the facility in the event of vehicle collisions. If US 90 were to shut down, a bypass for this would be near IH 10 W or the future frontage roads along IH 10 W, minimizing the inoperability period.

One bridge on the project segment is rated as being in fair condition according to FHWA guidance, with a minimum condition score of 6. The improvements will bring the pavement and bridge infrastructure up to TxDOT and FHWA standards and improve the state of good repair of the segment and the overall system. The bridges over Kellner Creek, Brookshire Creek, and Willow Fork Creek will be reconstructed on this project.

Planning Factors Criteria

3.95

11.84

The total crash rate for all crash types over the past five years was 100.53 crashes per 100 million vehicle miles. The fatal crash rate was 3.95 per 100 million vehicle miles, higher than the statewide average of 1.39. The serious injury crash rate was 11.84 per 100 million miles, greater than the statewide average of 5.95. The added capacity will improve regional connectivity for all modes while also improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment of US 90 up to current TxDOT and FHWA safety standards. This project will construct raised median improvements in some places which have been shown to reduce crash rates. There will also be a 8 Ft wide outside shoulder in the City of Brookshire Downtown section of US 90.

Resiliency

Medium

Low

This project has medium vulnerability to flooding. The project also includes the conversion of the existing open-ditch drainage to a closed stormwater system. The enhanced drainage system will improve regional resilience by reducing the risk of flooding on this roadway. All current projects are being designed to meet and/or exceed ATLAS-14 drainage standards. There will be a few potential detention ponds as well constructed with this project.

Access/Connectivity

4,821

8,156

Yes

No

Yes

Environmental Justice

4,821

8,156

1,379

1051

733

877

23.00

The project will improve mobility and connectivity for vulnerable populations through reducing traffic congestion and adding pedestrian and bicycle facilities, as well as improve connectivity to jobs, schools (Katy High School), medical facilities (Brookshire Family Practice and Miltens Clinic), and social services (Brookshire City Hall, Post Office, and Waller County Pct 4 Annex) for the area’s population.

This project mitigates adverse impacts on vulnerable populations by adding pedestrian and bicycle facilities. The project uses existing ROW and does not divide communities. The raised medians will provide the opportunity for another agency to plant/maintain landscaping in the median to mitigate air pollution and improve aesthetic values.

Impacts on Natural and Cultural Resources

No Cultural resources that could be impacted have been identified on this segment at this time. During construction Best Management Practices (BMP) will be done to prevent sediment pollution in the Kellner, Brookshire, and Willow Fork Creeks on this project.

H-GAC Staff, Please calculate Emissions reductions for us per email instructions 4/26/23.

Innovation

Yes

The project will implement new infrastructure technologies to enhance accessibility, mobility, multimodalism, resiliency, reliability, and traffic operations and will implement new autonomous/ connected vehicle technology. Brand new Signal Phasing and timing (SpAT) signals will be installed on service roads on this segment of the project as applicable (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads). This simply broadcasts red, green, and yellow times ahead of signalized intersections to connected vehicles newer than model year 2021 or if you have the apps (Traffic Safely and ConnectSmart) downloaded on your cell phone for older vehicles. This provides ample time for you to slow down before intersections because of the timing and to adequately adjust with flow of traffic- platooning. The advantages are improved safety because of a reduction of red-light-running crashes and carbon emission reductions resulting from better traffic platooning. While it might be part of CSJ 701 right now, this type of work could easily be done on these construction/reconstruction projects.

Yes

The project will implement new infrastructure technologies to enhance accessibility, mobility, multimodalism, resiliency, reliability, and traffic operations and will implement new autonomous/ connected vehicle technology. Brand new Signal Phasing and timing (SpAT) signals will be installed on service roads on this segment of the project as applicable (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads). This simply broadcasts red, green, and yellow times ahead of signalized intersections to connected vehicles newer than model year 2021 or if you have the apps (Traffic Safely and ConnectSmart) downloaded on your cell phone for older vehicles. This provides ample time for you to slow down before intersections because of the timing and to adequately adjust with flow of traffic- platooning. The advantages are improved safety because of a reduction of red-light-running crashes and carbon emission reductions resulting from better traffic platooning. While it might be part of CSJ 701 right now, this type of work could easily be done on these construction/reconstruction projects.

Additional Documents


2023HGAC-CFP-RGM-LOS-Brazoria County-Comm Pct 1 (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-City of Friendswood-Mayor (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-City of Galveston-Mayor (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-Port Freeport-Chairman (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-City of Pattison - Mayor (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-Waller County-County Judge (ALL RGM TxDOT Projects).pdf
