Regional Goods Movement Questionnaire

Project Information

Agency Name TxDOT Houston District

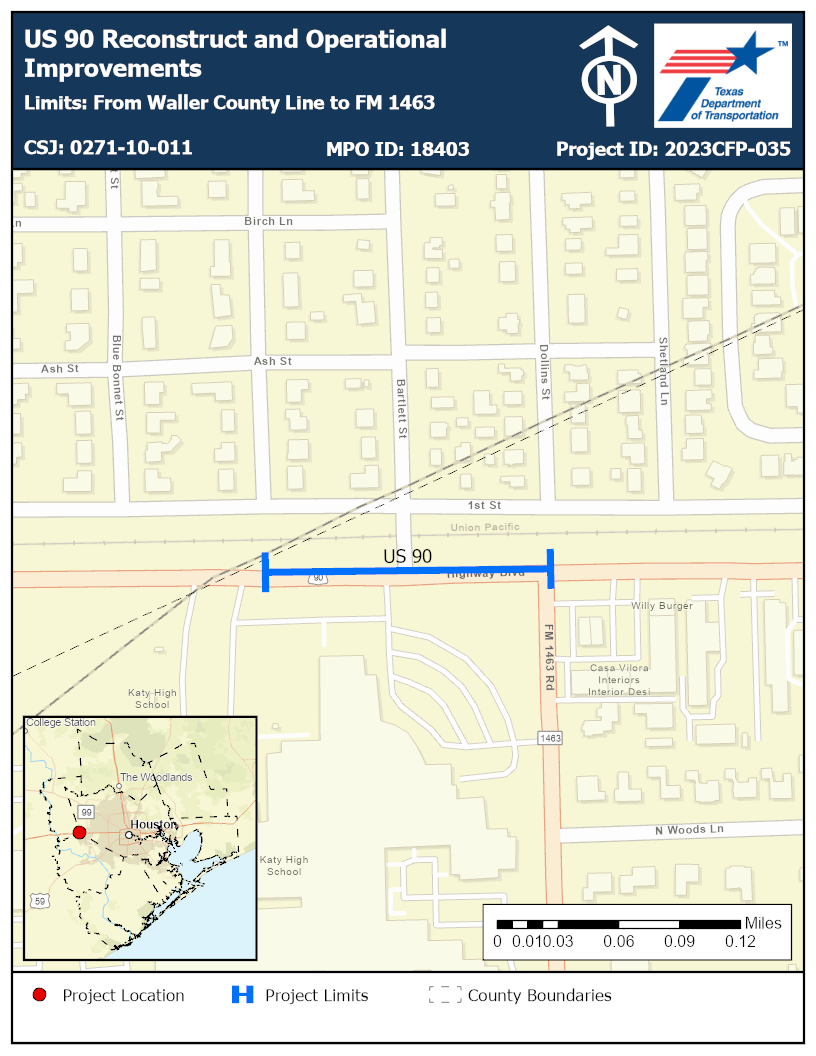

Project Title US 90 Reconstruct and Operational Improvements
Facility/Street/Highway US 90
Limits From Waller County Line to FM 1463
Description Reconstruct 4 lanes and operational improvements
Timeframe Medium Term (6-10 Years)
Estimated Cost $5,460,000.00

Investment Category-Focused Criteria

Yes

H-GAC 2023 Regional Goods Movement Study

https://engage.h-gac.com/regional-goods

Low

No

3.0

4.5

Yes

Yes

4,000,000

The project consists of reconstructing a 4-lane segment of US 90, divided from the Waller County Line to FM 1463. The project includes operational improvements in addition to reconstructing the 4 lanes, including installing raised medians and left turn bays. The project also includes construction of pedestrian and bicycle facilities and the conversion of the existing open-ditch drainage to a closed stormwater system. In addition to the reconstruction and widening of the existing roadway, the project will include improvements in the safety, drainage, and pavement condition. The project takes place in a high growth area of Waller County. It is listed in the H-GAC 2023 Regional Goods Movement Study and H-GAC RTP (MPOID 18403). US 90 connects to IH 10 W, which is a link on the Critical Urban Freight Network, as it sits on the Texas Highway Freight Network. In addition, the route parallels a major hurricane evacuation route. The purpose of the project is to reduce congestion on US 90 and to improve the capacity, connectivity, level of service and safety of the project segment and the Critical Urban Freight Network in the region. This improvement, in conjunction with the other adjacent proposed improvements, will improve freight access to many major freight generators in the region including the region’s seaports, airports (Houston Executive Airport), manufacturing facilities, and freight warehouses. The project connects all the warehouses in the Katy-Brookshire area north of IH 10 W and south of US 90 including but not limited to the recently constructed Empire West Business Park. The capacity increase will also be balanced with improvements to the pedestrian and bicycle facilities in the corridor. Sidewalks and/or wide shoulders/shared use paths are being constructed on this project that will enhance safety for all users. This segment of US 90 runs parallel to IH 10 W which is classified as a state evacuation route.

No

No

No

Yes

This segment of US 90 runs parallel to IH 10 W which is classified as a state evacuation route.

Other Investment Category Focused Criteria

This section of US 90 is heavily used and needs additional capacity. According to the TxDOT Roadway Inventory, the current daily volume of traffic on the segment is roughly 11190 vehicles per day. The estimated percent increase in volume from 2021 to 2041 is estimated to be approximately 40 percent, with truck traffic representing 4.5 percent after implementation of the project. This will improve traffic flow that gets impeded waiting for trucks or vehicles to left turn into warehouse facilities. The purpose of the project is to reduce congestion on US 90 and to improve the connectivity, level of service and safety of the project segment and the Critical Urban Freight Network in the region. The operational improvements will improve regional connectivity for all modes while also reducing congestion and improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment of up to TxDOT and FHWA safety standards.

The project takes place in a high growth area of Fort Bend County and nearby Waller County. It connects all the warehouses in Katy/Brookshire area north of IH 10 W/South of US 90 including, but not limited to, recently constructed Empire West Business Park and Anserra Business Park. The proposed project alleviates future congestion due to potential economic development activity such as expansion of warehouses or other freight generators.

As required by state design guidelines, the capacity increase will also be balanced with the addition or improvement of pedestrian and bicycle facilities in the corridor. Shared use paths are being constructed on both sides of this project for use by pedestrians and cyclists.

There are no transit services currently operating on US 90, but future service could use the additional lanes in the future.

The project will add lanes and improve the shoulders to allow more space to move disabled vehicles and to better maintain flow on the facility vehicle collisions. If US 90 were to shut down, IH 10 W or the future frontage roads on IH 10 W could act as alternative routes, thus minimizing an inoperability period.

The project includes the conversion of the existing open-ditch drainage to a closed stormwater system. The enhanced drainage system will improve regional resilience by reducing the risk of flooding on this roadway. There will be a detention pond construction on a neighboring segment of this project but not far from this segment (county line difference is what separates the two projects). All current projects are being designed to meet and/or exceed ATLAS-14 drainage standards. The roadway will get reconstructed and brought up to current design standards.

Planning Factors Criteria

0

30.18

The average crash rate for all crash types over the past five years was 331.93 crashes per 100 million vehicle miles traveled. The serious injury crash rate was 30.18, significantly higher than the statewide average of 5.95. The operational improvements will improve regional connectivity for all modes while also improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment of US 90 up to TxDOT and FHWA safety standards. Raised medians and right/left turn lanes will be constructed at the intersection of FM 1463.

Resiliency

Low

Low

The project includes the conversion of the existing open-ditch drainage to a closed stormwater system. The enhanced drainage system will improve regional resilience by reducing the risk of flooding on this roadway. There will be a detention pond construction on a neighboring segment of this project but not far from this segment (county line difference is what separates the two projects). All current projects are being designed to meet and/or exceed ATLAS-14 drainage standards.

Access/Connectivity

983

4,527

No

Yes

No

Environmental Justice

983

4,527

137

736

520

9

6.70

The project will improve mobility and connectivity for vulnerable populations through reducing traffic congestion and adding pedestrian and bicycle facilities, as well as improve connectivity to schools (Katy High School), medical facilities, and social services (Katy City Hall nearby) for the area’s population.

All current projects are being designed to meet and/or exceed ATLAS-14 drainage standards (reduce flooding). Any sound walls that are identified prior/during the National Environmental Policy Act (NEPA) process will be constructed on this project, otherwise the corridor is mostly industrial and commercial land uses that front on US 90. The raised medians will provide the opportunity for another agency to plant/maintain landscaping in the median to mitigate air pollution and improve aesthetic values.

Impacts on Natural and Cultural Resources

No Cultural resources that could be impacted have been identified on this segment at this time. During construction Best Management Practices (BMP) will be done to prevent sediment pollution from draining toward Snake Creek and Buffalo Bayou.

H-GAC Staff, Please calculate Emissions reductions for us per email instructions 4/26/23.

Innovation

Yes

The project will implement new infrastructure technologies to enhance accessibility, mobility, multimodalism, resiliency, reliability, and traffic operations and will implement new autonomous/ connected vehicle technology. Brand new Signal Phasing and timing (SpAT) signals will be installed on service roads on this segment of the project as applicable (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads). This simply broadcasts red, green, and yellow times ahead of signalized intersections to connected vehicles newer than model year 2021 or if you have the apps (Traffic Safely and ConnectSmart) downloaded on your cell phone for older vehicles. This provides ample time for you to slow down before intersections because of the timing and to adequately adjust with flow of traffic- platooning. The advantages are improved safety because of a reduction of red-light-running crashes and carbon emission reductions resulting from better traffic platooning. While it might be part of CSJ 701 right now, this type of work could easily be done on these construction/reconstruction projects.

Yes

The project will implement new infrastructure technologies to enhance accessibility, mobility, multimodalism, resiliency, reliability, and traffic operations and will implement new autonomous/ connected vehicle technology. Brand new Signal Phasing and timing (SpAT) signals will be installed on service roads on this segment of the project as applicable (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads). This simply broadcasts red, green, and yellow times ahead of signalized intersections to connected vehicles newer than model year 2021 or if you have the apps (Traffic Safely and ConnectSmart) downloaded on your cell phone for older vehicles. This provides ample time for you to slow down before intersections because of the timing and to adequately adjust with flow of traffic- platooning. The advantages are improved safety because of a reduction of red-light-running crashes and carbon emission reductions resulting from better traffic platooning. While it might be part of CSJ 701 right now, this type of work could easily be done on these construction/reconstruction projects.

Additional Documents


2023HGAC-CFP-RGM-LOS-Brazoria County-Comm Pct 1 (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-City of Friendswood-Mayor (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-City of Galveston-Mayor (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-City of Pattison - Mayor (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-Port Freeport-Chairman (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-Waller County-County Judge (ALL RGM TxDOT Projects).pdf
