Operational Improvements and Congestion Management Questionnaire

Project Information

Agency Name TxDOT Houston District
Project Title FM 1128 Widening
Facility/Street/Highway FM 1128

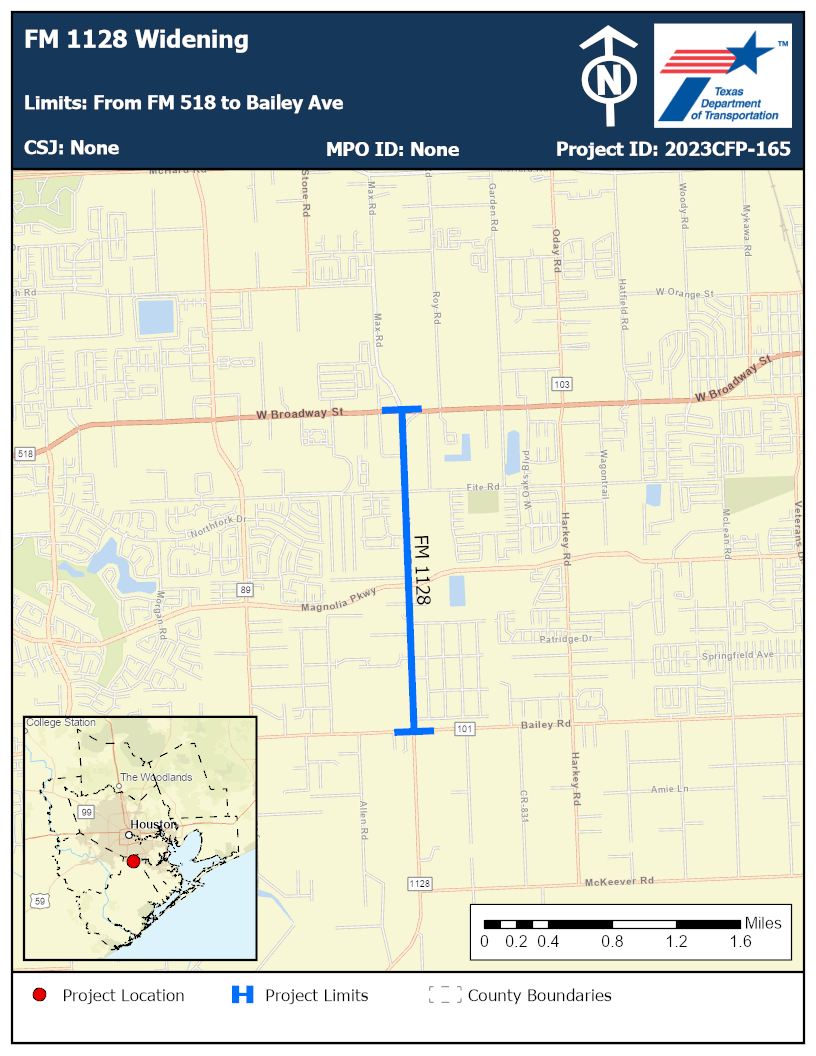

Limits From FM 518 to Bailey Ave
Description Widen from a 2-lane to a 4-lane divided roadway
Timeframe Long Term (More than 10 Years)
Estimated Cost $23,000,000.00

Investment Category-Focused Criteria

No

1.0 – 1.25

Travel Time Index (TTI) is a ratio that compares peak period travel times along a corridor to average travel times, thus estimating a relative level of rush hour congestion. Current TTI for the project area is 1.10, indicating that it takes 1.10 times as long to travel this corridor in the peak period than average, which is mildly congested.

1.0 – 1.25

Travel Time Index (TTI) is a ratio that compares peak period travel times along a corridor to average travel times, thus estimating a relative level of rush hour congestion. Current TTI for the project area is 1.10, indicating that it takes 1.10 times as long to travel this corridor in the peak period than average, which is mildly congested.

The project includes the following Congestion Management Strategy: Added Capacity and Access Management. Adding capacity will relieve congestion in the facility by allowing for a reduced vehicle-to-capacity ratio. Further, it will allow more room for traffic to avoid crashes on the segment, reducing congestion caused by crashes. As an access management strategy in corridors, medians reduce mid-block left turn-related crashes. They enhance traffic flow and reduce the quantity and severity of crashes at intersections and resulting congestion.

No

Yes

FM 1128 runs parallel to SH 288 and directly connects to SH 6, both of which are identified as evacuation routes.

Other Investment Category Focused Criteria

No

The project is not located on a Critical Urban Freight Corridor. The project is not located on the TxDOT or FHWA Freight Networks. The project improves regional goods movement by adding capacity which will relieve congestion.

The project is located in a high growth area. The population is projected to grow by 81.3% and jobs are projected to increase by 142.8%. No notable land use changes announced or modeled.

Sidewalks or shared use paths will most likely be built on one side or both sides of this project. Shared use paths provide a low-stress experience for active transportation users, increasing user safety and health while improving regional connectivity. The addition of sidewalks will create transportation alternatives and allow pedestrians greater access to services and improve quality of life.

No existing or planned transit service is provided on this facility. H-GAC Pearland Transit Study may recommend service in this vicinity.

The project will widen lanes to allow more space to move disabled vehicles and to better maintain flow on the facility after vehicle collisions.

Pavement Score: Good Worst bridge score: Good Narrative: The pavement on this facility is mostly in good condition, according to TxDOT and FHWA guidelines. In a widening/reconstruction project like this project, pavement is removed, and new pavement is constructed, thus increasing the state of good repair and extending the service life of the facility.

Planning Factors Criteria

2.925

35.103

Crash rates for this segment are per 100 million VMT. The fatality rate is 2.925, higher than the regional average (1.23), and the serious injury rate is 35.103, higher than the regional average, (6.18). The proposed widening of the roadway aims to increase its capacity, mitigating primary and secondary crashes attributed to congestion. As part of the project, there is a high likelihood of constructing sidewalks or shared-use paths, potentially on one side or both sides. The addition of pedestrian infrastructure will allow pedestrians to safely use the facility and reduce points of conflict with vehicles, thus further enhancing the overall safety and accessibility of the area. The consolidated crash reduction factor for this project is 110% as a result of installing pedestrian and bicycle infrastructure (WC 407) and converting a 2-lane facility to a 4-lane divided (WC 538).

Resiliency

Low

Low

All current projects are being designed to meet and/or exceed ATLAS-14 drainage standards.

Access/Connectivity

6,763

10,527

Yes

Yes

Yes

Environmental Justice

6,763

10,527

910

422

350

1,201

16.70

The area surrounding the project segment has a lower low-income population (5.55%) as compared to the regional average of 13.5%. The area surrounding the project segment has a lower minority population (64.22%) as compared to the regional average of 65% minority. Because of its central location in the regional network, the project will produce improvements in mobility and connectivity for vulnerable populations as well as connectivity to schools, medical facilities, and social services for the regional population.

The area surrounding the project segment has a lower low-income population (5.55%) as compared to the regional average of 13.5%. The area surrounding the project segment has a lower minority population (64.22%) as compared to the regional average of 65% minority. TxDOT’s Environmental Process is designed to ensure compliance with Title VI of the Civil Rights Act of 1964, and the Executive Order on Environmental Justice. Standard practice is to implement projects that provide user safety and operational efficiency while taking into account environmental quality and impacts on surrounding communities. In practice this means identifying and assessing potential project impacts, and then proposing measures to avoid, minimize, and/or mitigate disproportionately high and adverse effects to Environmental Justice Populations.

Impacts on Natural and Cultural Resources

This project is in conceptual development. If required, the appropriate Environmental Document (Categorical Exclusion, Environmental Assessment, or Environmental Impact Statement) will be conducted to identify, avoid or mitigate potential impacts to the natural or human environment.

NOx: -0.16 ; VOC: -0.47

Innovation

Yes

Brand new Signal Phasing and timing (SpAT) signals will be installed on this segment of the project (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads)

Yes

Brand new Signal Phasing and timing (SpAT) signals will be installed on this segment of the project (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads)
