High Growth Area Needs Questionnaire

Project Information

Agency Name TxDOT Houston District

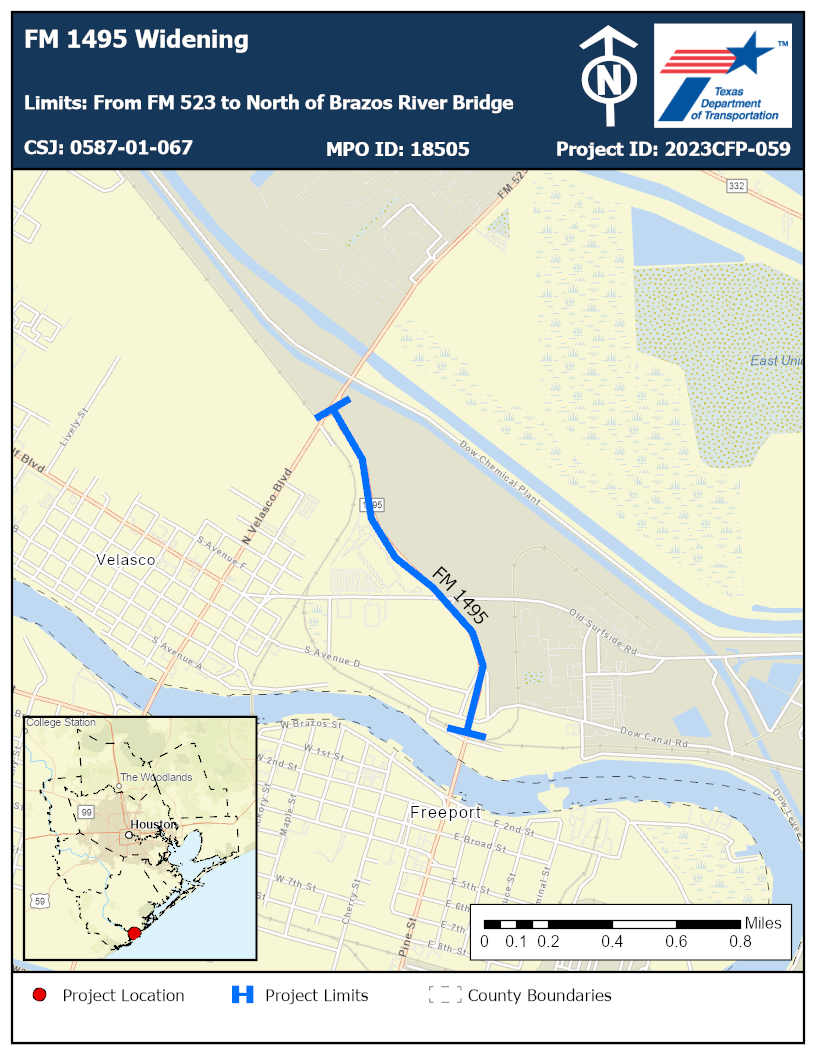

Project Title FM 1495 Widening
Facility/Street/Highway FM 1495
Limits From FM 523 to North of Brazos River Bridge
Description Widen from 2-lane to 4 -lane roadway
Timeframe Medium Term (6-10 Years)
Estimated Cost $17,000,000.00

Investment Category-Focused Criteria

The project is located in a high growth area. The population is projected to grow by 301.8% and jobs are projected to increase by 98.9%. While land use changes have not yet been announced or modeled, additional residential land uses will be needed in the future to accommodate the projected growth. This segment of FM 1495 will benefit from improved connectivity and improved level of service that will result from this improvement. The average daily volume of traffic on this segment in 2021 was 6,996 with 5.7 percent of that being truck traffic. By 2041 daily traffic volume is expected to increase by 39.99 percent, especially if the Port of Freeport continues to expand and grow. The purpose of the project is to improve capacity, connectivity, level of service, and safety of the project segment. The added capacity will improve regional connectivity for all modes while also reducing congestion and improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment of FM 1495 up to TxDOT and FHWA safety standards.

Yes

https://www.h-gac.com/getmedia/28624d53-96f2-48aa-9c7a-766ebf5b3e0f/brazoria-county-thoroughfare-plan.pdf

This project will widen from 2-lane to 4 -lane roadway. A roundabout (Work Code 547) will be constructed as well at the intersection of CR 229 (Old Surfside Road) and shoulders will be provided.

Yes

The project is located in a high growth industrial area, next to Port Freeport. The population is projected to grow by 301.8% and jobs are projected to increase by 98.9%. No land use changes announced or modeled. Land around this project corridor is undeveloped but could be industrialized very quickly given the growth of Port Freeport to the south of this location.

Yes

This project will add capacity. Adding capacity will relieve congestion on the facility by allowing for a reduced vehicle to capacity ratio. Further, it will allow more room for traffic to avoid crashes on the segment, reducing congestion caused by crashes.

LOS A

Yes

The route supplements access to the Port of Freeport that is also provided by SH 288 and Velasco Blvd, all of which can serve as alternate routes to each other in case of inoperability.

No

Yes

Model.HighGrowthAreaNeedsQuestionnaire.InvestmentCategory5ai

Other Investment Category Focused Criteria

Yes

This segment of FM 1495 will benefit from improved connectivity and improved level of service that will result from this improvement. The average daily volume of traffic on this segment in 2021 was 6,996 with 5.7 percent of that being truck traffic. By 2041 daily traffic volume is expected to increase by 39.99 percent. The purpose of the project is to improve capacity, connectivity, level of service, and safety of the project segment. The added capacity will improve regional connectivity for all modes while also reducing congestion and improving safety by reducing primary and secondary crashes due to congestion and by bringing the segment of FM 1495 up to TxDOT and FHWA safety standards. Intersection Improvements at CR 229 will be reconstructed to a roundabout.

10ft shared use shoulder will be built on both sides of this project per the schematic. Shared use shoulders provide for active transportation users, increasing user safety and health while improving regional connectivity.

No existing or planned transit service is provided on this facility.

The project will widen lanes to allow more space to move disabled vehicles and to better maintain flow on the facility after vehicle collisions.

Pavement Score: Good Narrative: The pavement on this facility is mostly in Good condition, according to TxDOT and FHWA guidelines. This segment contains a bridge in Poor condition according to FHWA guidelines. It was built in 1967 and last rehabilitated in 2010. It has a superstructure condition score of 4, substructure condition score of 6, and a deck condition score of 4. In a widening/reconstruction project like this project, pavement is removed and new pavement is constructed, thus increasing the state of good repair and extending the service life of the facility.

Planning Factors Criteria

0

58.094

The Crash rates for this segment are per 100 million vehicle miles traveled. The fatality rate is 0, lower than the regional average (1.23), and the serious injury rate is 58.094, higher than the regional average (6.18). The widening of the roadway from an existing two-lane to a four-lane divided roadway will provide additional capacity to the roadway and reduce primary and secondary crashes caused by congestion. The addition of pedestrian infrastructure will allow cyclists and pedestrians to safely use the facility and reduce points of conflict with vehicles, thus improving the overall safety of the segment." The consolidated crash reduction factor for this project is 68%, as a result of converting from a 2-lane to a 4-lane facility (WC 517) and building shoulder (WC 537). A roundabout (WC 547) is being constructed on this project as well to reduce intersection crashes.

Resiliency

Low

Model.HighGrowthAreaNeedsQuestionnaire.Resiliency2

All current projects are being designed to meet and/or exceed ATLAS-14 drainage standards.

Access/Connectivity

4,295

2,850

No

No

No

Environmental Justice

4,295

2,850

862

655

209

111

61.90

The area surrounding the project segment has a higher low-income population (20.47%) as compared to the regional average of 13.5%. The area surrounding the project segment has a higher minority population (67.66%) as compared to the regional average of 65% minority. Because of its central location in the regional network, the project will produce improvements in mobility and connectivity for vulnerable populations as well as connectivity to schools, medical facilities, and social services for the regional population. The project will improve drainage to ATLAS-14 standards, which reduce flooding events and their impact on vulnerable populations. As a result of the improvement, vulnerable populations will have increased resilience and evacuation capacity in the event of hazards.

The area surrounding the project segment has a higher low-income population (20.47%) as compared to the regional average of 13.5%. The area surrounding the project segment has a higher minority population (67.66%) as compared to the regional average of 65% minority. TxDOT’s Environmental Process is designed to ensure compliance with Title VI of the Civil Rights Act of 1964, and the Executive Order on Environmental Justice. Standard practice is to implement projects that provide user safety and operational efficiency while taking into account environmental quality and impacts to surrounding communities. In practice this means identifying and assessing potential project impacts, then proposing measures to avoid, minimize and/or mitigate disproportionately high and adverse effects to Environmental Justice Populations. For example, the project will improve drainage to ATLAS-14 standards, which will mitigate impacts from added capacity to vulnerable populations.

Impacts on Natural and Cultural Resources

This project is currently classified as a type of action that qualifies as a “Categorical Exclusion” as it is not expected to have a significant effect on the human and natural environment. If through the NEPA environmental analysis process TxDOT determines that the proposed action does not qualify as a CE, then an Environmental Assessment (EA) would be prepared to identify, mitigate and avoid impacts to natural and cultural resources.

0,0

Innovation

Yes

Brand new Signal Phasing and timing (SpAT) signals will be installed on this segment of the project (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads)

Yes

Brand new Signal Phasing and timing (SpAT) signals will be installed on this segment of the project (Related to CSJ 0912-00-701 that will install 1,100+ of these signals on all traffic lights on TxDOT HOU district roads)
