Major Projects Questionnaire

Project Information

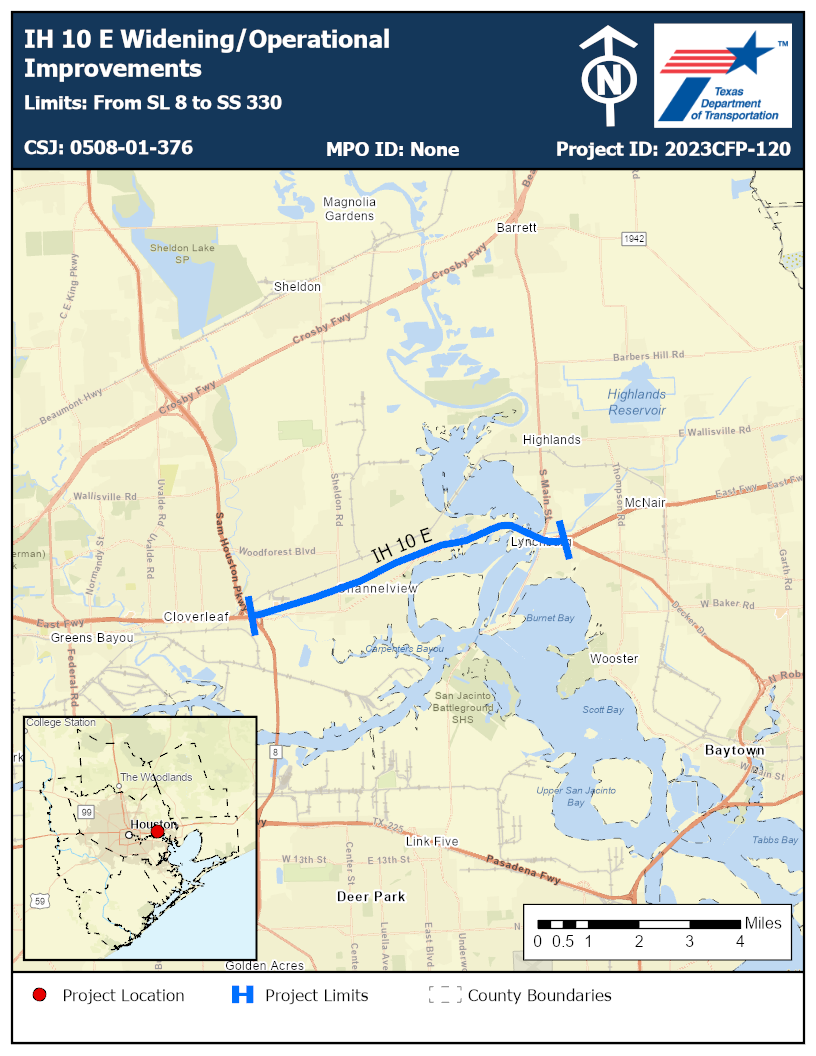

Agency Name TxDOT Houston District
Project Title IH 10 E Widening/Operational Improvements
Facility/Street/Highway IH 10 E
Limits From SL 8 to SS 330
Description RECONSTRUCT AND WIDEN FROM 8 TO 12 LANE (ADD 4 MANAGED LANES) - Safety, operational and mobility improvements to IH 10 mainlanes and frontage roads, based on results of the IH 10 East PEL study
Timeframe Medium Term (6-10 Years)
Estimated Cost $313,000,000.00

Regional Transportation Plan Goals

According to the 2045 RTP, this project falls under H-GAC’s Manage, Maintain, and Expand strategies, which collectively directly support all five of H-GAC’s goals of improving safety, achieving/maintaining a state of good repair, moving people and goods efficiently, strengthening regional economic competitiveness, and protecting cultural and natural resources. [1] Improve Safety: This project will provide additional capacity to the roadway and reduce primary and secondary crashes caused by congestion. [2] Achieve & Maintain State of Good Repair: In a widening/reconstruction project, old pavement is removed, and new pavement is constructed, thus increasing the state of good repair. [3] Move People and Goods Reliably and Efficiently: This project will reduce congestion and reduce resulting crashes, increasing the reliability of the facility. [4] Strengthen Regional Economic Competitiveness: This project will reduce congestion and resulting crashes, increasing the truck travel time reliability of the facility, boosting regional and economic competitiveness. [5] Conserve and Protect Natural and Cultural Resources: This project will include improved drainage, which will benefit the natural resources abutting the facility. This project will reduce emissions caused by idling and congestion.

Regional Significance

Roadway

Principal Arterial or Higher Functional Class

Potential Crash Reductions

1.06

2.385

Crash rates for this segment are per 100 million VMT. The fatality rate is 1.06, lower than the statewide average (1.23), and the serious injury rate is 2.385, lower than the statewide average, (6.18). The reconstruction and widening of the roadway will provide additional capacity to the roadway and reduce primary and secondary crashes caused by congestion. In addition, the project will include safety improvements as outlined in the IH 10 East PEL study. Managed lanes are vital for reducing congestion and offering drivers more reliable timeframes for getting to their destinations, adjusting lane strategies as needed to maximize roadway efficiency, and improving traffic flow on both the managed and general-purpose lanes. The addition of pedestrian infrastructure will allow pedestrians to safely use the facility and reduce points of conflict with vehicles, thus improving the overall safety of the segment. The consolidated crash reduction factor for this project is 93%, as a result of installing sidewalks (WC 407) and providing additional travel lanes (WC 517).

Potential Congestion Reductions

No

1.0 – 1.25

Travel Time Index (TTI) is a ratio that compares peak period travel times along a corridor to average travel times, thus estimating a relative level of rush hour congestion. Current TTI for the project area is 1.18, indicating that it takes 1.18 times as long to travel this corridor in the peak period than average, which is mildly congested.

Adding capacity will relieve congestion on the facility by allowing for a reduced vehicle to capacity ratio. Further, it will allow more room for traffic to avoid crashes on the segment, reducing congestion caused by crashes. The segment will be brought up to TxDOT and FHWA safety design standards.

Connectivity to Jobs, Medical Facilities, and Activity Centers

Yes

5,254

Yes

Yes

This segment of IH 10 E will be reconstructed and add capacity (additional managed lanes as well) to address congestion. This corridor connects Downtown Baytown to East Houston and many industrial facilities (including the Port of Houston and all the warehouses around the SL 8 interchange, not to mention the ExxonMobil Refinery near SS 330 interchange) that provide thousands of jobs. The Kindred Hospital East Houston is located on this project corridor.

State of Good Repair

53 years

Poor

Segments of the project have pavement in Poor condition, according to TxDOT and FHWA guidelines. This segment contains bridges in Fair condition, according to FHWA guidelines. The worst bridge on this project segment was built in 1971 and last rehabilitated in 2008. It is rated as being in Fair condition overall, with a superstructure condition score of 6, substructure condition score of 5, and a deck condition score of 6. In a widening/reconstruction project like this project, pavement is removed and new pavement is constructed, thus increasing the state of good repair and extending the service life of the facility.

Biking and Walking Conditions

Frontage roads will have sidewalks/shared use paths on them per the IH 10 E PEL Study. Shared use paths provide a low-stress experience for active transportation users, increasing user safety and health while improving regional connectivity. The addition of sidewalks will create transportation alternatives and allow pedestrians greater access to services and improve quality of life.

Impacts to Vulnerable Populations

11,244

12,081

3,816

1,503

367

2,050

49.50

"The area surrounding the project segment has a higher low-income population (23.96%) as compared to the regional average of 13.5%. The area surrounding the project segment has a higher minority population (75.41%) as compared to the regional average of 65% minority. Because of its central location in the regional network, the project will produce improvements in mobility and connectivity for vulnerable populations as well as connectivity to schools, medical facilities, and social services for the regional population. As a result of the improvement, vulnerable populations will have increased resilience and evacuation capacity in the event of hazards. According to HGAC’s Regional Resilience Tool, the project segment sits on a facility that is rated as having High vulnerability to storm surge and flooding and is ranked as moderate criticality for accessing key facilities. IH 10 E is an evacuation route. The project will improve drainage to ATLAS-14 standards, which reduce flooding events and their impact on vulnerable populations. The project will increase access to and reliability of transit services for vulnerable populations, who generally rely more on these services. The region in which this project sits is scored 49.50 out of 100, according to the H-GAC Livable Centers Index. The improvement will improve the area’s Livable Index score by contributing to creating an area easily accessible by multimodal transportation opportunities. "

The area surrounding the project segment has a higher low-income population (23.96%) as compared to the regional average of 13.5%. The area surrounding the project segment has a higher minority population (75.41%) as compared to the regional average of 65% minority. TxDOT’s Environmental Process is designed to ensure compliance with Title VI of the Civil Rights Act of 1964, and the Executive Order on Environmental Justice. Standard practice is to implement projects that provide user safety and operational efficiency while taking into account environmental quality and impacts to surrounding communities. In practice this means identifying and assessing potential project impacts, then proposing measures to avoid, minimize and/or mitigate disproportionately high and adverse effects to Environmental Justice Populations. For example, the project will improve drainage to ATLAS-14 standards, which will mitigate impacts from added capacity to vulnerable populations.

Hurricane Evacuation Route

Yes

Additional Documents

2023HGAC-CFP-RGM-LOS-Brazoria County-Comm Pct 1 (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-City of Friendswood-Mayor (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-City of Galveston-Mayor (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-City of Pattison - Mayor (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-Port Freeport-Chairman (ALL RGM TxDOT Projects).pdf

2023HGAC-CFP-RGM-LOS-Waller County-County Judge (ALL RGM TxDOT Projects).pdf

2023CFP-120 map.png
